This report details the progress of multiple facilities modernization projects at LAS Positas College as of April 16, 2012. Highlights include the completion of storefront installation and ongoing work on glazing, interior framing, and data cabling for student services and central administration. Updates on the Science Building, Campus Boulevard phases, and the Photovoltaic System indicate significant progress towards occupancy dates scheduled from Spring to Fall 2012. Collaboration among architects, construction managers, and contractors is supporting timely project advancements.
E N D
Facilities Modernization Program Funded by Measure B Project Report April 16, 2012
PROJECT PROGRESS REPORT Student Services & Central Administration LAS POSITAS COLLEGE April 16, 2012 • Project Team: • Architect: Steinberg Architects • Construction Manager: Parsons Brinckerhoff • Contractor: Zovich Construction • Project Update: • Storefront installation is complete. Glazing is 75% installed in the Storefronts • Curtainwall installation has started. Glazing to begin April 20 • Interior framing continues on the first floor west side in the dining/kitchen area. • Data cable has started being pulled on the second floor east side • Sheetrock has started on one side of the walls. • Elevators are delivered and awaiting installation. • Mechanical units were delivered and installed on the roof. Occupancy: Spring 2013
PROJECT PROGRESS REPORT Science Building, Phase II LAS POSITAS COLLEGE April 16, 2012 • Project Team: • Architect: Kwan Hemni • Construction Manager: Parsons Brinckerhoff • Contractor: Broward Builders, Inc • Project Update: • Interior Casework, Lighting and Fume hoods continue to be installed. • Ceiling Tiles being installed in all rooms, Power to building 95% complete, Elevator starts week of April 16, 2012 • Stair Treads and Guardrails are completed. • Greenhouse being installed. • Exterior and Interior Painting is complete. Restrooms completed. • 2nd floor classrooms are completed. • Storefront installation and Glazing Completed. Occupancy: 09/2012
PROJECT PROGRESS REPORT Campus Boulevard Phase I-III LAS POSITAS COLLEGE April 16, 2012 • Project Team: • Architect: Gates & Associates • Construction Manager: Parsons Brinckerhoff • Contractor: Suarez & Munoz Construction, Inc. Project Update: • 100% Design review completed, final design was Approved by DSA February 2012. • Project was Bid on March 13, 2012 and Contractor will be Board Approved April 17, 2012. • Design Re-Start: 04/2011 • DSA Permit Approval: 02/2012 • Construction Start: 05/2012 Occupancy: 10/2012

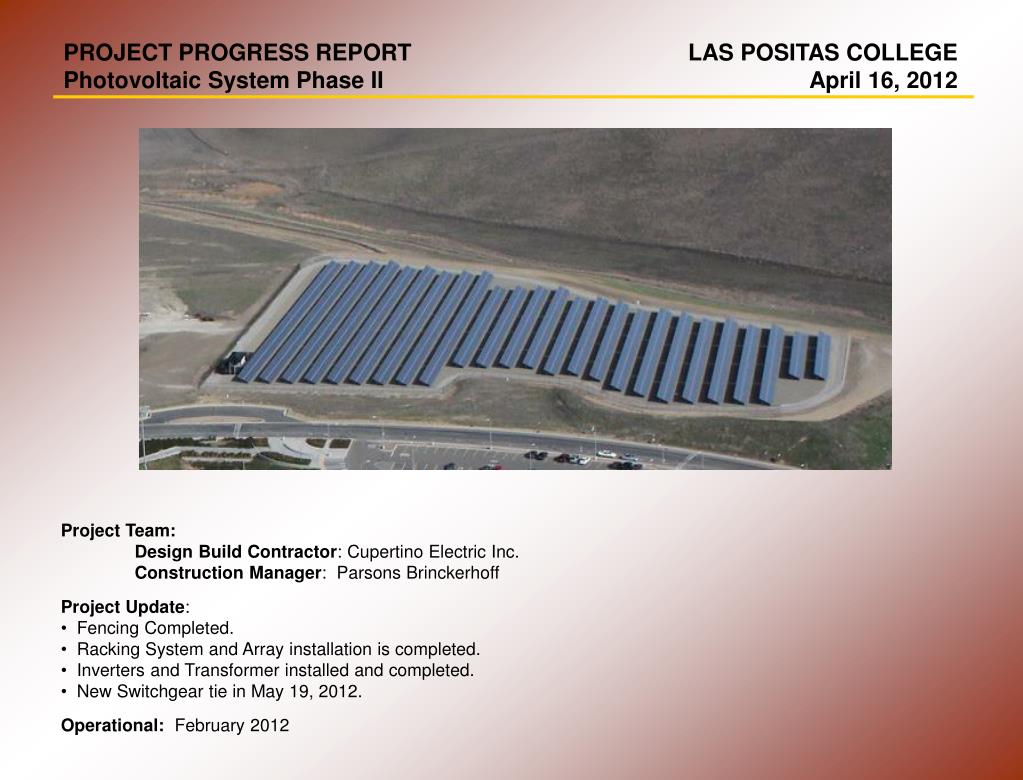

PROJECT PROGRESS REPORT Photovoltaic System Phase II LAS POSITAS COLLEGE April 16, 2012 • Project Team: • Design Build Contractor: Cupertino Electric Inc. • Construction Manager: Parsons Brinckerhoff Project Update: • Fencing Completed. • Racking System and Array installation is completed. • Inverters and Transformer installed and completed. • New Switchgear tie in May 19, 2012. Operational: February 2012
