1 / 68

North Lamar ISD 2009 Bond Projects

North Lamar ISD 2009 Bond Projects. With the passage of the May 2009 NLISD Bond Election, campuses made improvements and repairs. New flooring in the elementary schools, updated kitchen equipment campus-wide, resurfacing of the high school parking lot, roof repairs at Stone Middle School.

xarles
Télécharger la présentation

North Lamar ISD 2009 Bond Projects

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. North Lamar ISD2009 Bond Projects

  2. With the passage of the May 2009 NLISD Bond Election, campuses made improvements and repairs. New flooring in the elementary schools, updated kitchen equipment campus-wide, resurfacing of the high school parking lot, roof repairs at Stone Middle School.

  3. Rock was added to the south wing of Aaron Parker Elementary. Wood siding Matching stone

  4. The $4.16 million designated for new construction enabled the North Lamar High School to meet the new ‘4x4’ curriculum requirements by adding additional science and computer labs.

  5. NLISD maintenance crew, directed by Tommy Funderburg, moved the fiber optic cable.

  6. Our technology team, directed by Glenda Parson, got the connections back up and working. These two teams saved the district some construction costs.

  7. Construction equipment moved on sight 11/09/09. Prior to this start date the canopy from the high school to the special education building was removed and the grounds surrounding the site were prepared for the construction.

  8. NovemberConstruction

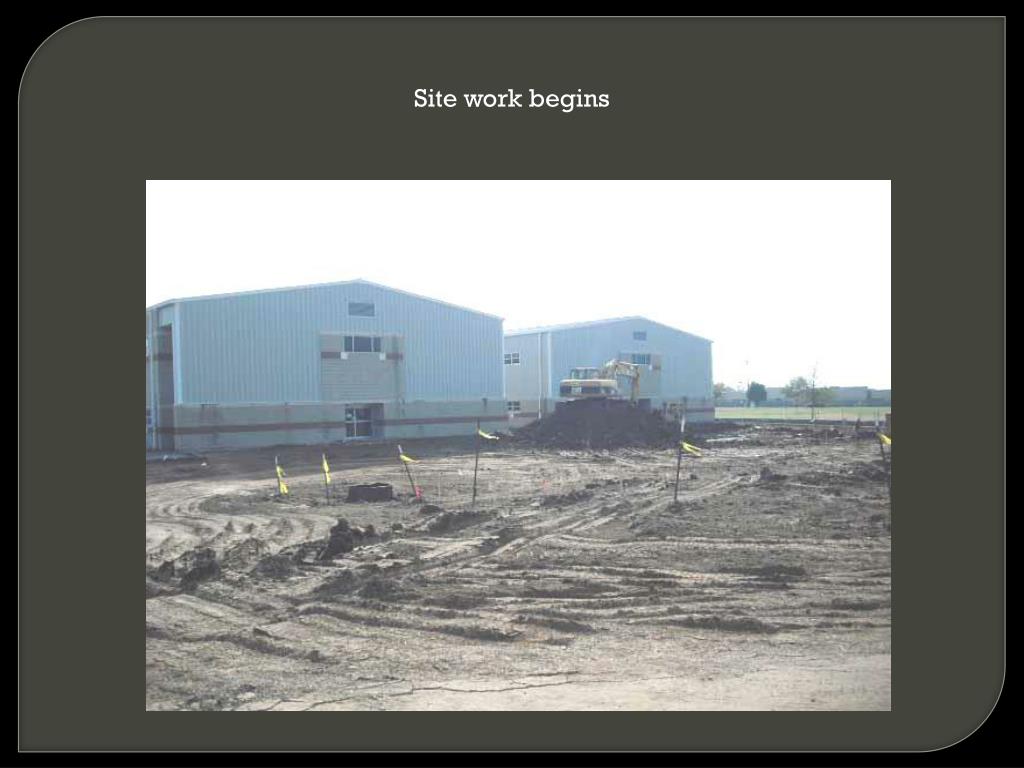

  9. Site work begins

  10. Trench for Fiber Optic

  11. DecemberConstruction

  12. Drilling to Set Piers

  13. Drilled Pier

  14. Science Lab Grade Beam

  15. JanuaryConstruction

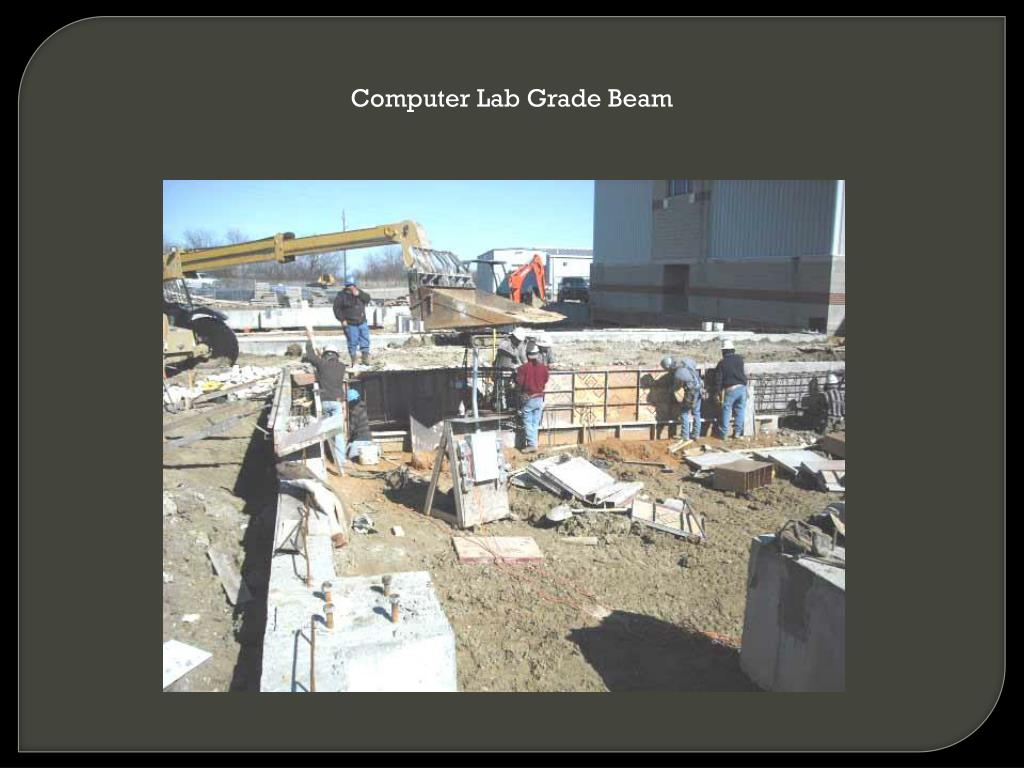

  16. Computer Lab Grade Beam

  17. Soil Retainer

  18. Steel Beams

  19. FebruaryConstruction

  20. Plumbing Begins

  21. Steel Construction

  22. Snow!

  23. Under Floor Piping Insulation

  24. Under Floor Electrical

  25. Steel Floor Decking

  26. Floor Mesh

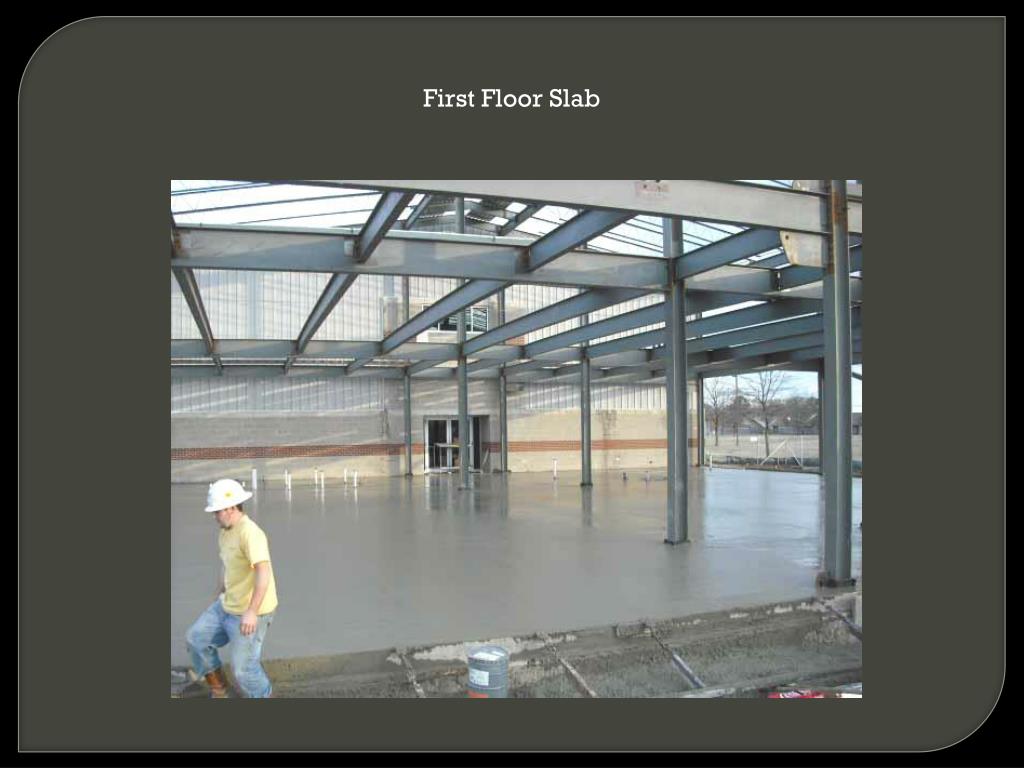

  27. First Floor Slab

  28. MarchConstruction

  29. First Floor Above Slab Plumbing

  30. Second Floor Concrete Slab

  31. AprilConstruction

  32. HVAC Duct Work

  33. Interior Wall

  34. Science Storage Area

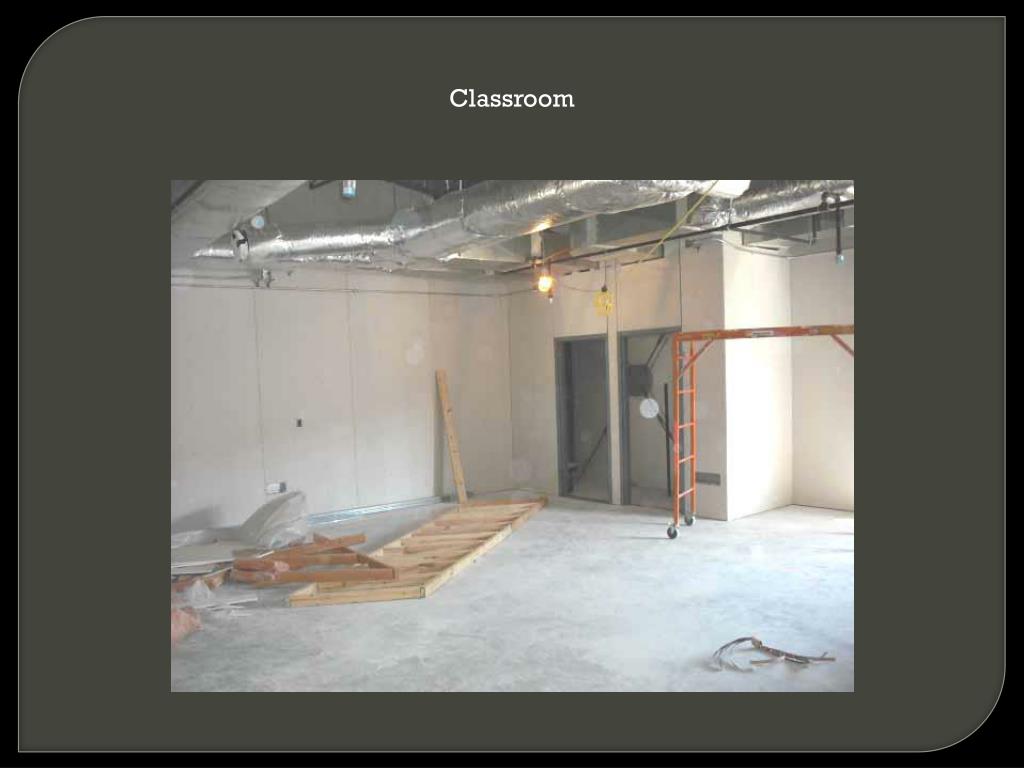

  35. Classroom

  36. Science Classroom

  37. New Wallway

More Related
