Project Update: Financial Systems Replacement Project

DESCRIPTION

Project Update: Financial Systems Replacement Project. CITI Meeting March 31, 2010. Prior Status – November 2009. Full funding (-10%) in July 2009 Project Director – full time in October First meeting of Executive Sponsors Committee

1 / 12

Télécharger la présentation

Project Update: Financial Systems Replacement Project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Project Update: Financial Systems Replacement Project CITI Meeting March 31, 2010

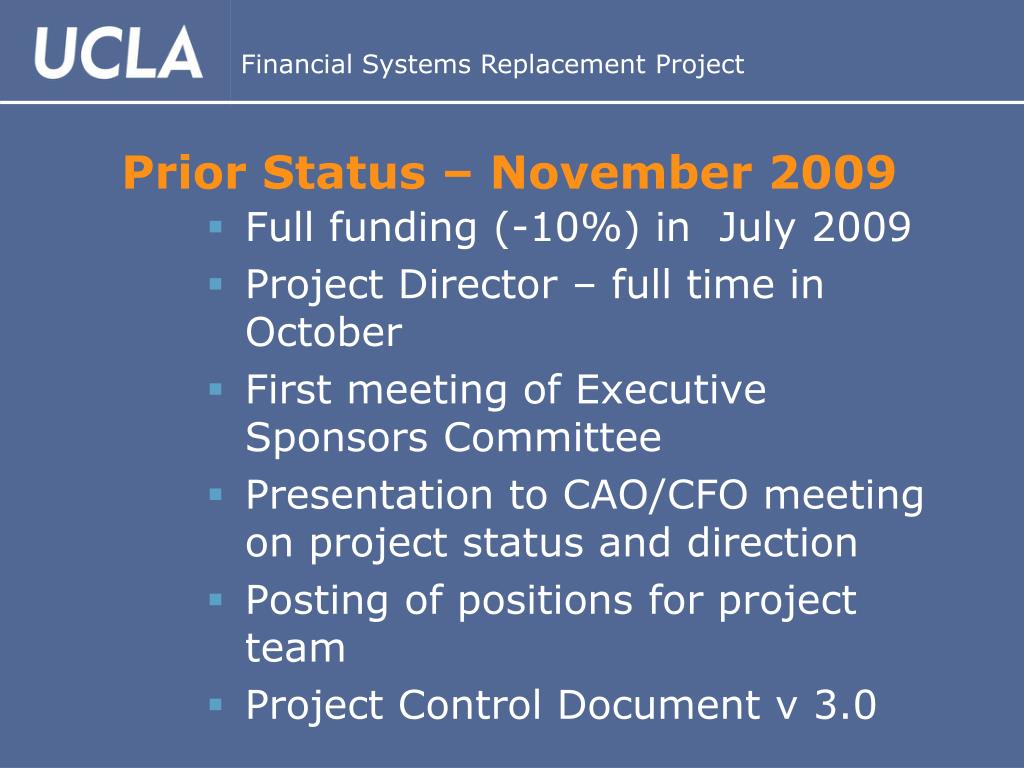

  2. Prior Status – November 2009 • Full funding (-10%) in July 2009 • Project Director – full time in October • First meeting of Executive Sponsors Committee • Presentation to CAO/CFO meeting on project status and direction • Posting of positions for project team • Project Control Document v 3.0

  3. Project Update: Meetings • Quarterly meetings with Executive Sponsor Committee set up for calendar year 2010 • Appointment of Management Committee letter sent out by EVC Scott Waugh • Management Committee meeting set for April 13th • Management Committee to provide names of workgroup members

  4. Current Updates: Staffing

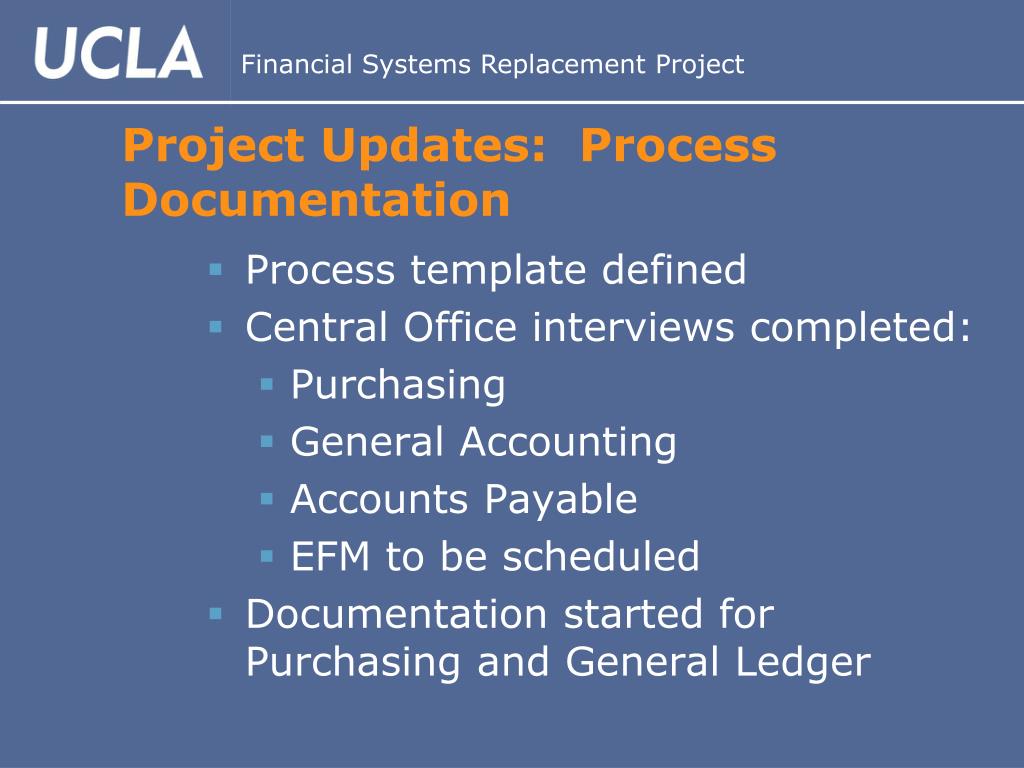

  5. Project Updates: Process Documentation • Process template defined • Central Office interviews completed: • Purchasing • General Accounting • Accounts Payable • EFM to be scheduled • Documentation started for Purchasing and General Ledger

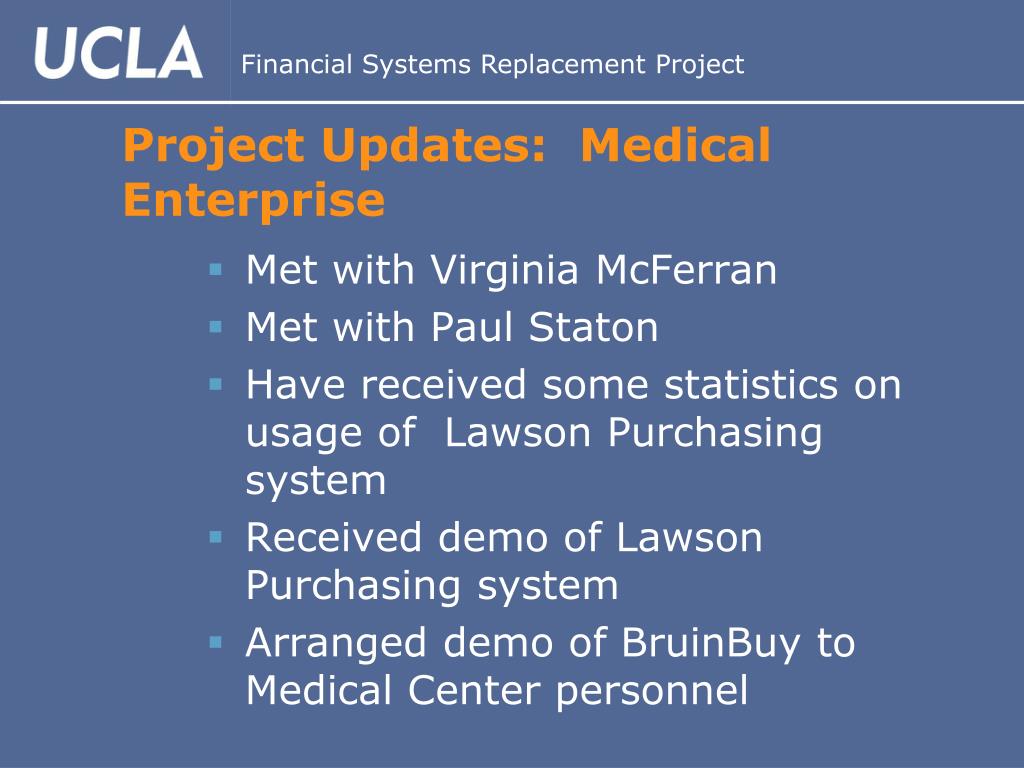

  6. Project Updates: Medical Enterprise • Met with Virginia McFerran • Met with Paul Staton • Have received some statistics on usage of Lawson Purchasing system • Received demo of Lawson Purchasing system • Arranged demo of BruinBuy to Medical Center personnel

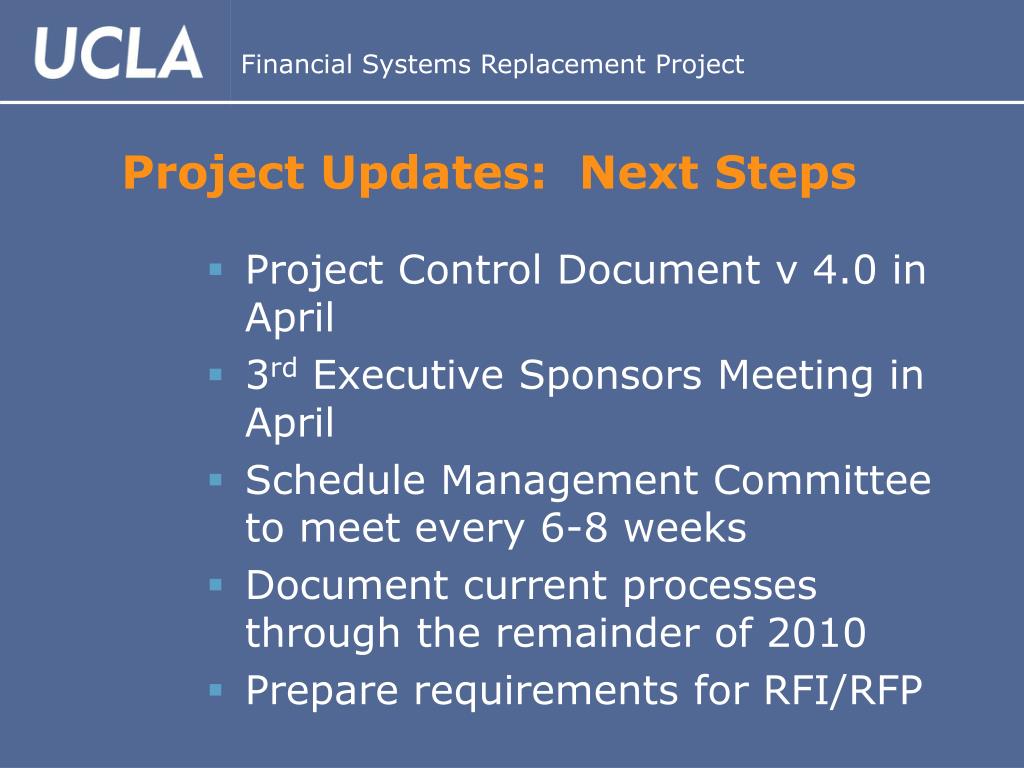

  7. Project Updates: Next Steps • Project Control Document v 4.0 in April • 3rd Executive Sponsors Meeting in April • Schedule Management Committee to meet every 6-8 weeks • Document current processes through the remainder of 2010 • Prepare requirements for RFI/RFP

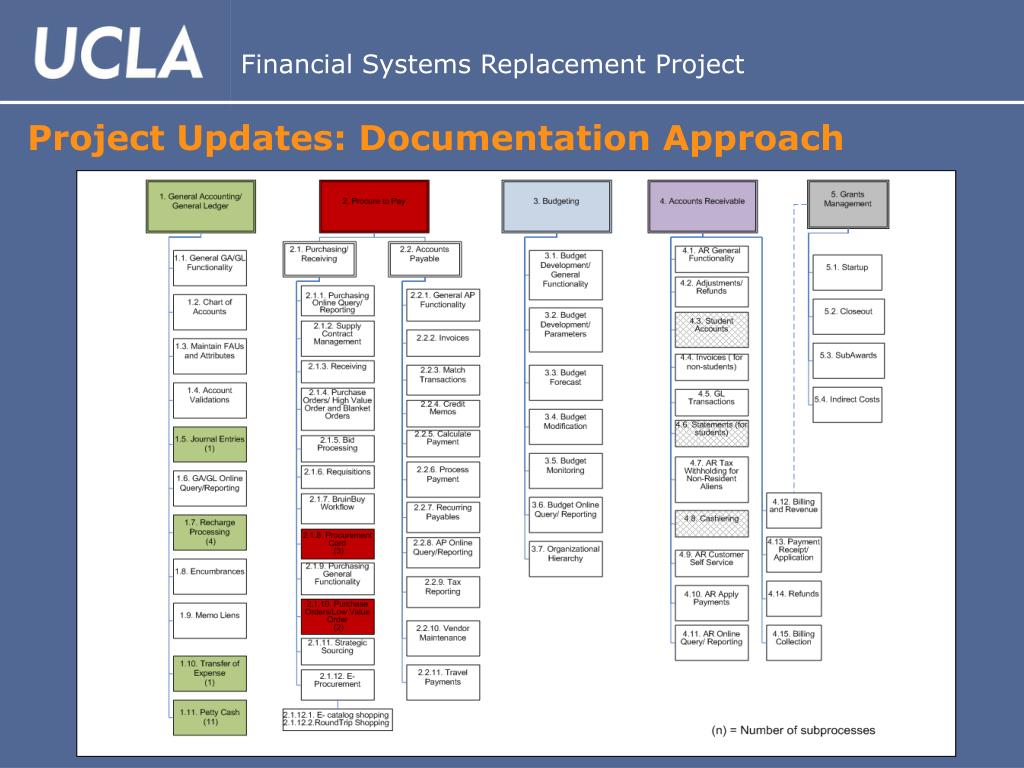

  8. Project Updates: Documentation Approach • Current processes – team, central office, campus workgroup review • Identification of areas for improvement, missed opportunities • Create use/test cases to be used for demos of ERP systems • Correct/change/improve any documentation for training purposes

  9. Project Updates: Documentation Approach

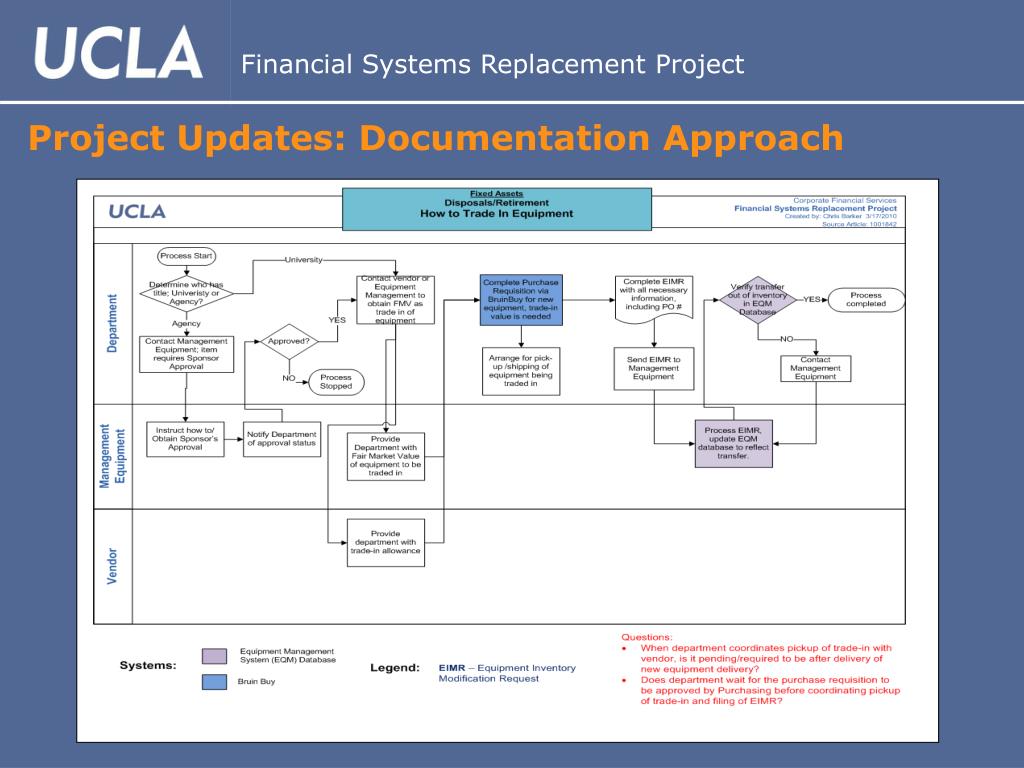

  10. Project Updates: Documentation Approach

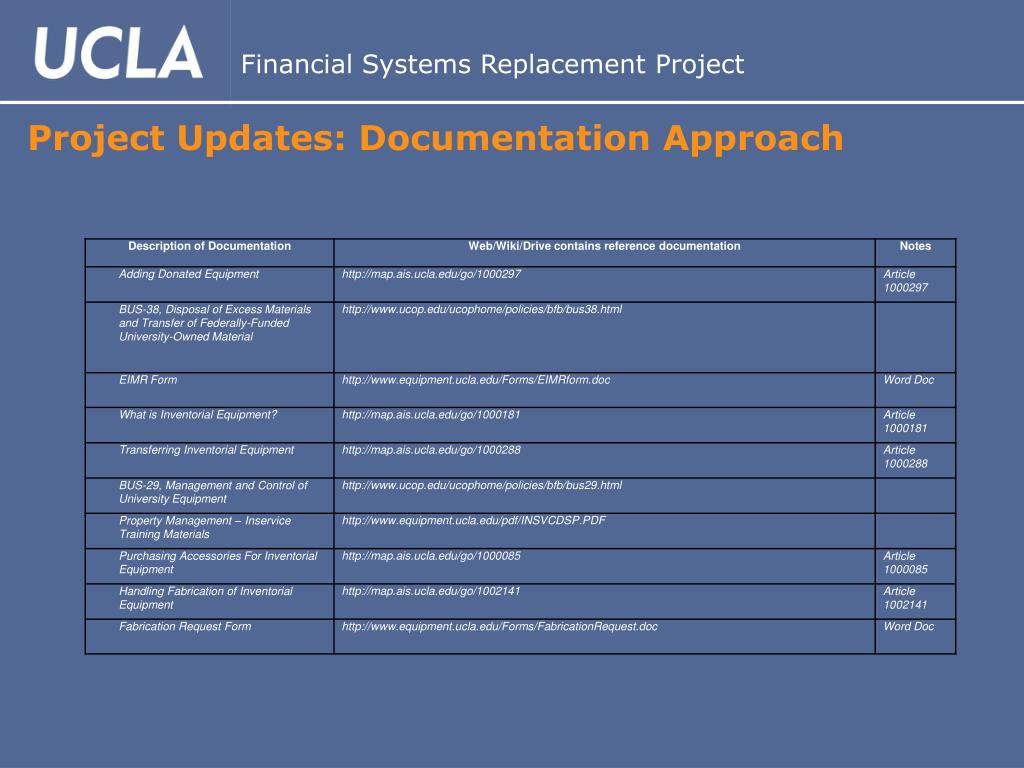

  11. Project Updates: Documentation Approach

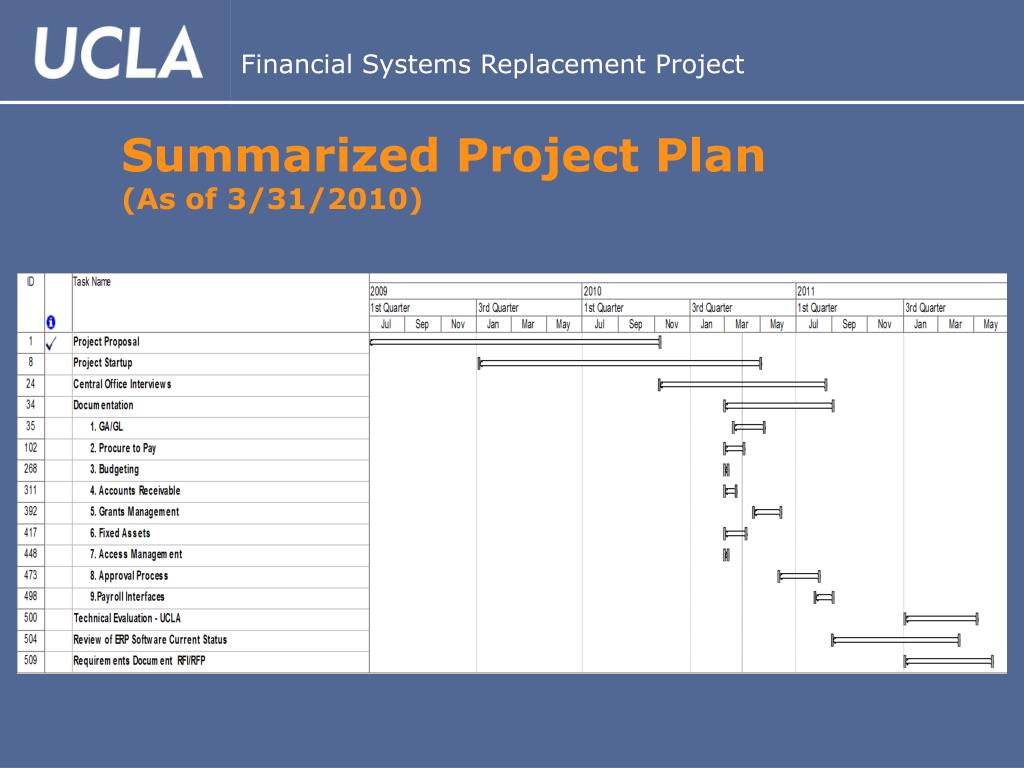

  12. Summarized Project Plan (As of 3/31/2010)
