Out-of-Order OpenRISC Stage 1: Implementation of OpenRISC on XUP5 board Project Characterization. By: Vova Menis-Lurie Sonia Gershkovich Advisor: Mony Orbach. Spring Semester 2012. Content:. 1.Project Overview a. Goals
E N D
Out-of-Order OpenRISCStage 1: Implementation of OpenRISC on XUP5 board Project Characterization By: Vova Menis-Lurie Sonia Gershkovich Advisor: Mony Orbach Spring Semester 2012
Content: 1.Project Overview a. Goals b. Background and the challenge 2. Specifications a. OpenRISC 1200 b. Working Environment 3. Workflow 4. Timetable – Gantt Chart

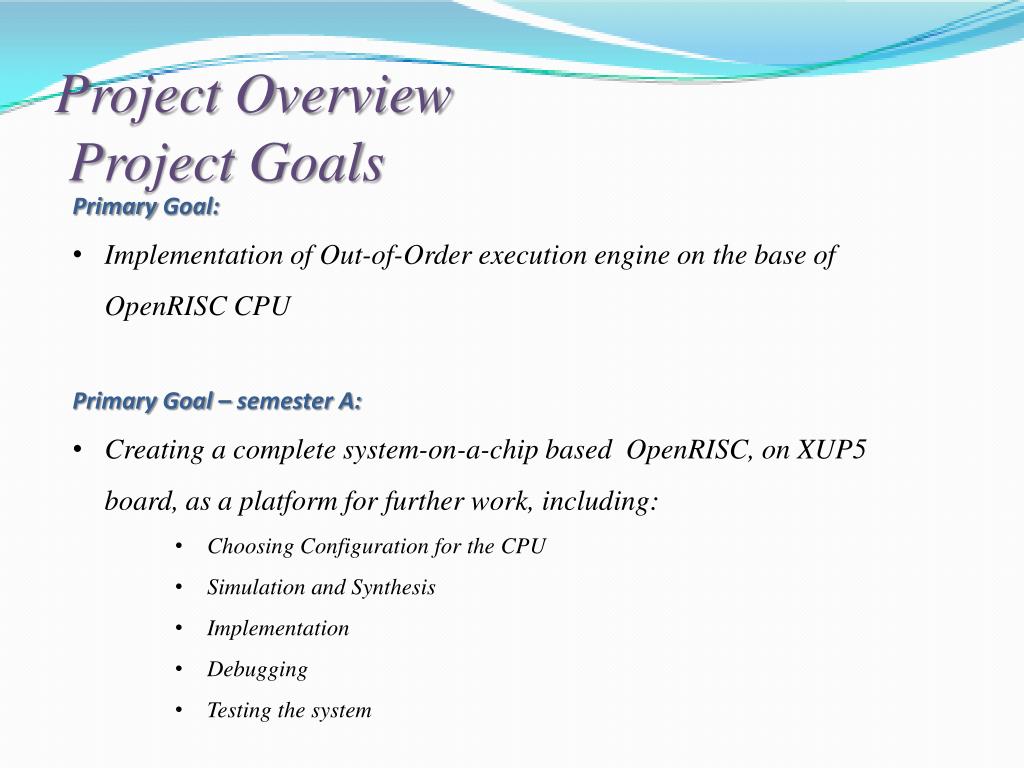

Project Overview Project Goals • Primary Goal: • Implementation of Out-of-Order execution engine on the base of OpenRISC CPU • Primary Goal – semester A: • Creating a complete system-on-a-chip based OpenRISC, on XUP5 board, as a platform for further work, including: • Choosing Configuration for the CPU • Simulation and Synthesis • Implementation • Debugging • Testing the system

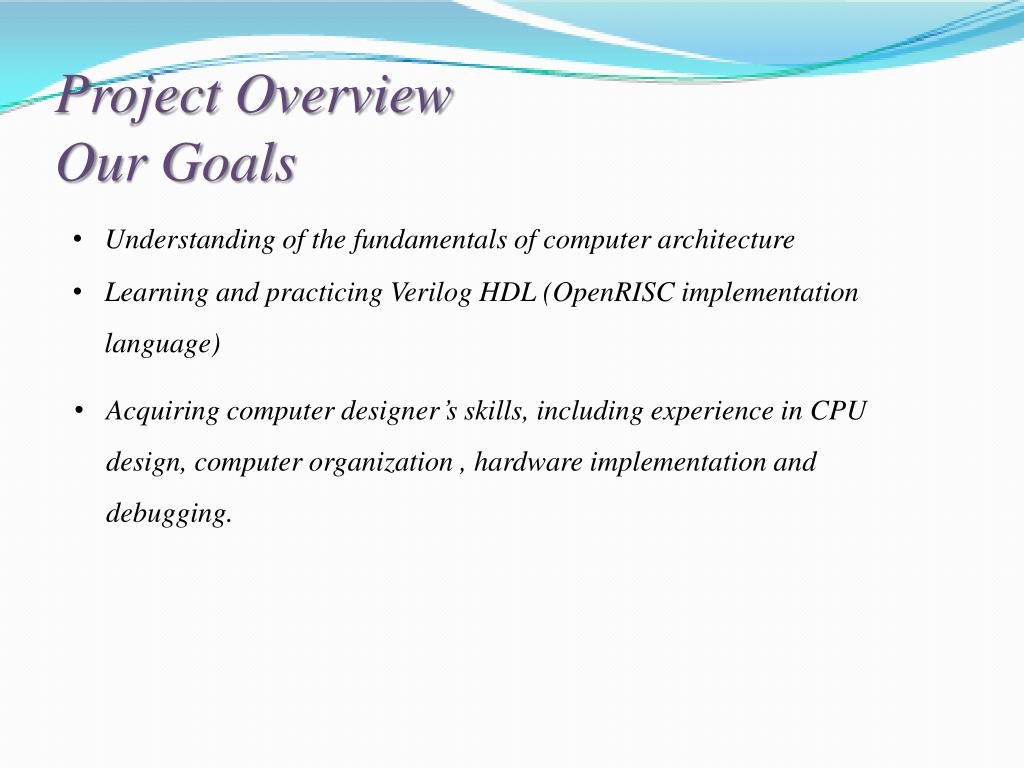

Project Overview Our Goals • Understanding of the fundamentals of computer architecture • Learning and practicing Verilog HDL (OpenRISC implementation language) • Acquiring computer designer’s skills, including experience in CPU design, computer organization , hardware implementation and debugging.

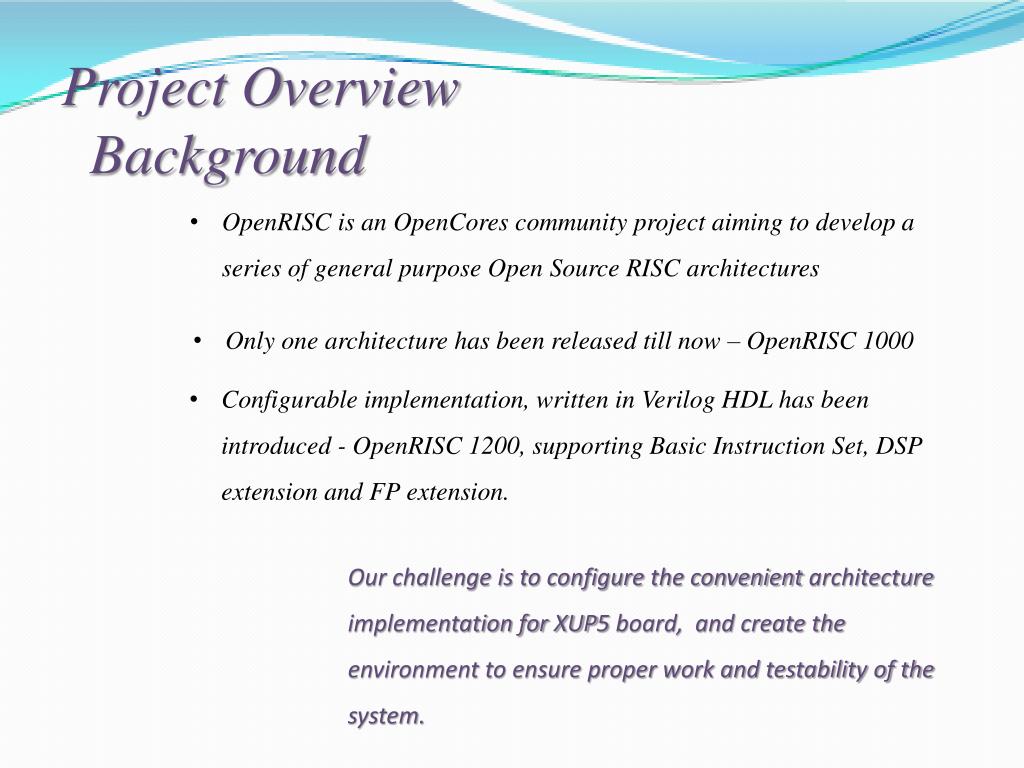

Project Overview Background • OpenRISC is an OpenCores community project aiming to develop a series of general purpose Open Source RISC architectures • Only one architecture has been released till now – OpenRISC 1000 • Configurable implementation, written in Verilog HDL has been introduced - OpenRISC 1200, supporting Basic Instruction Set, DSP extension and FP extension. Our challenge is to configure the convenient architecture implementation for XUP5 board, and create the environment to ensure proper work and testability of the system.
The OpenRISC 1200 • Original Unit Scheme • Starting Configuration for Project (may be changed)
The OpenRISC 1200 CPU DWB IWB IMMU PIC DC IC DU PM TT
I/O Signals • Data Wishbone Signals • Instruction Wishbone Signals • System Signals • Optional Units Signals

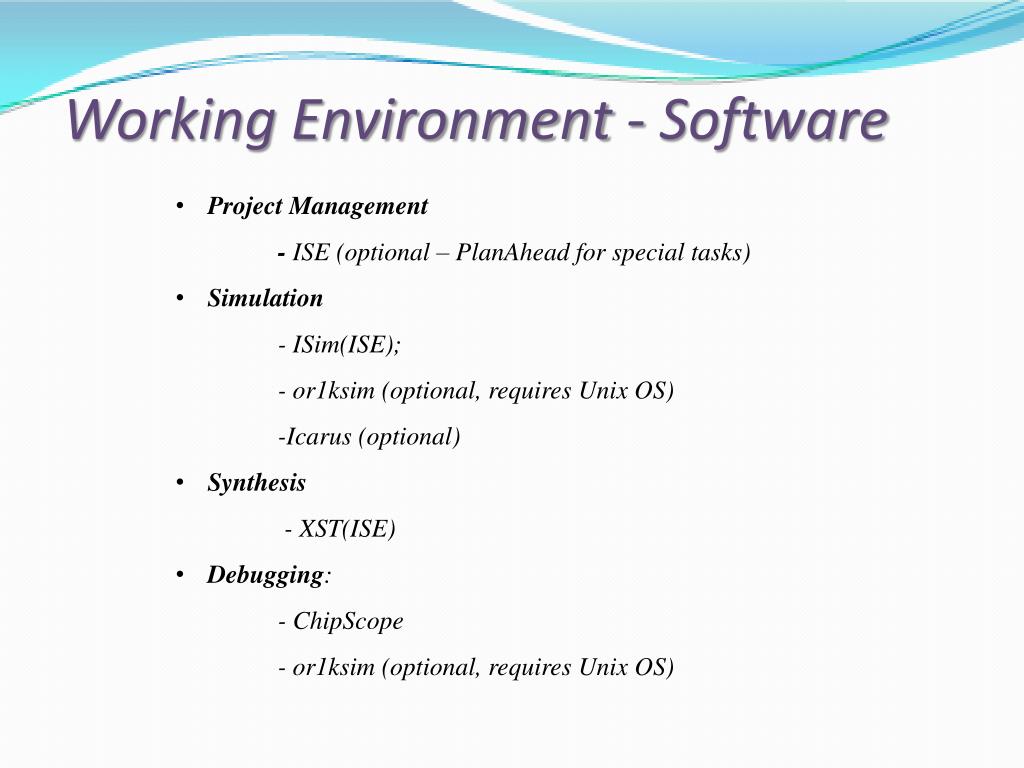

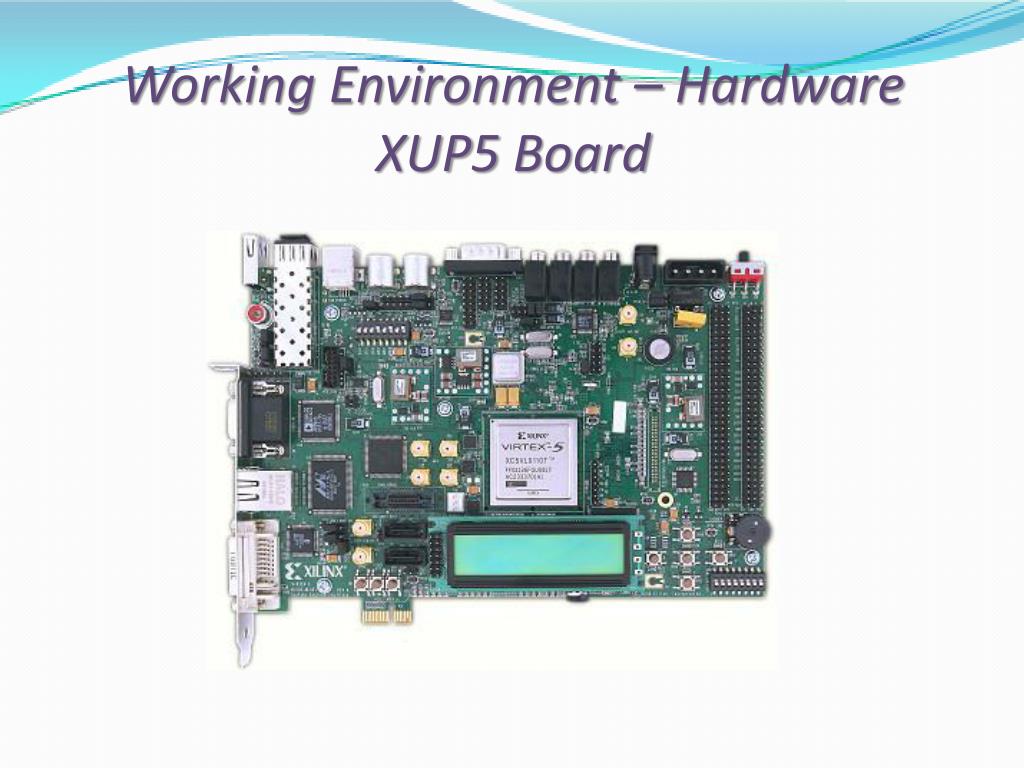

Working Environment - Software • Project Management • - ISE (optional – PlanAhead for special tasks) • Simulation • - ISim(ISE); • - or1ksim (optional, requires Unix OS) • -Icarus (optional) • Synthesis • - XST(ISE) • Debugging: • - ChipScope • - or1ksim (optional, requires Unix OS)

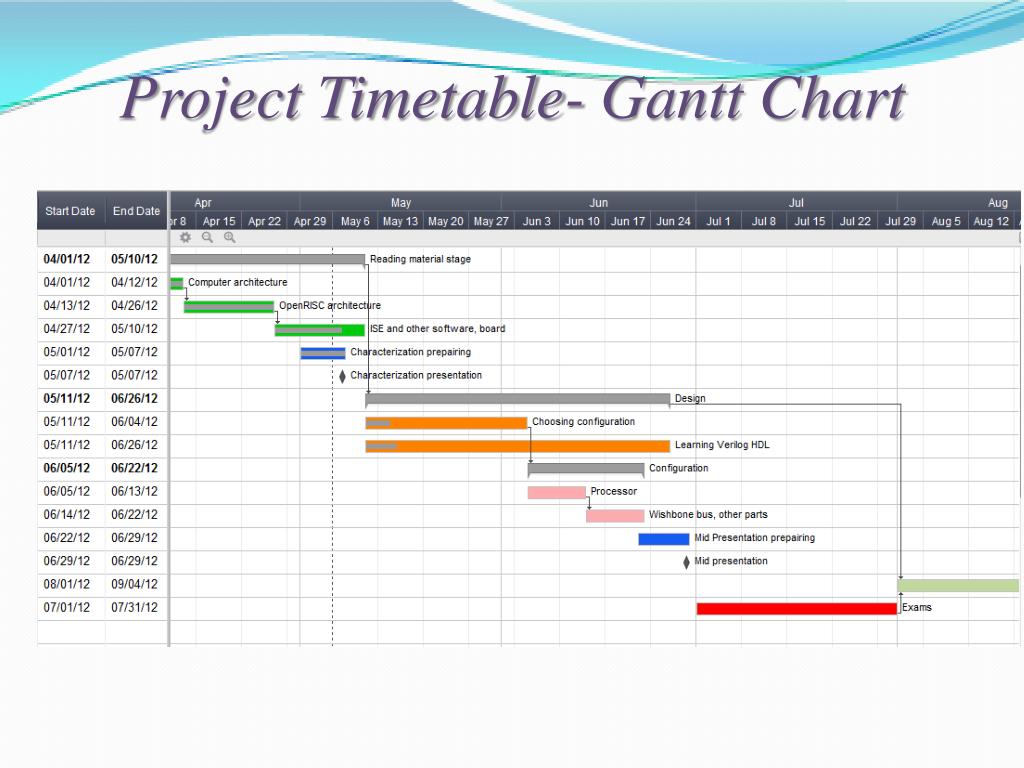

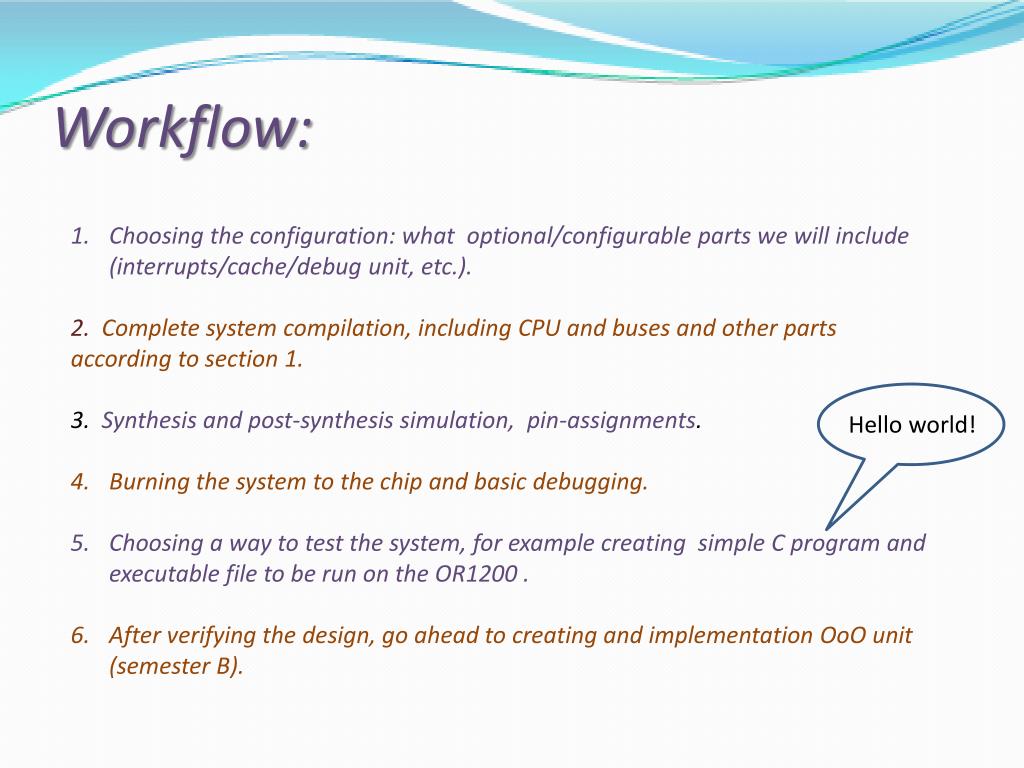

Workflow: Choosing the configuration: what optional/configurable parts we will include (interrupts/cache/debug unit, etc.). 2. Complete system compilation, including CPU and buses and other parts according to section 1. 3. Synthesis and post-synthesis simulation, pin-assignments. Burning the system to the chip and basic debugging. Choosing a way to test the system, for example creating simple C program and executable file to be run on the OR1200 . After verifying the design, go ahead to creating and implementation OoO unit (semester B). Hello world!
