1 / 32

Earned Value Analysis

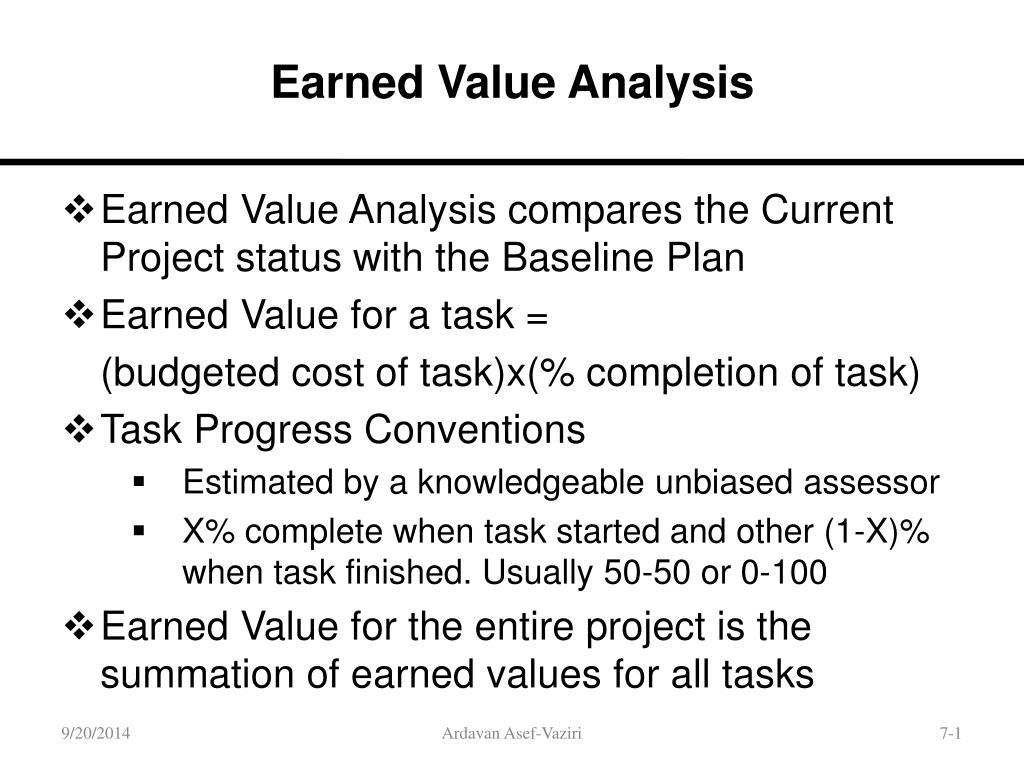

Earned Value Analysis. Earned Value Analysis compares the Current Project status with the Baseline Plan Earned Value for a task = (budgeted cost of task)x(% completion of task) Task Progress Conventions Estimated by a knowledgeable unbiased assessor

march
Télécharger la présentation

Earned Value Analysis

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Earned Value Analysis • Earned Value Analysis compares the Current Project status with the Baseline Plan • Earned Value for a task = (budgeted cost of task)x(% completion of task) • Task Progress Conventions • Estimated by a knowledgeable unbiased assessor • X% complete when task started and other (1-X)% when task finished. Usually 50-50 or 0-100 • Earned Value for the entire project is the summation of earned values for all tasks 9/20/2014 Ardavan Asef-Vaziri 7-1

  2. PV, EV, and AC PV: Planned Value, baseline cost of scheduled work. Also known as Budgeted Cost of Work Scheduled (BCWS) AC: Actual cost of work performed. Also shown by (ACWP) EV: Earned Value, budgeted cost of work performed. Also shown by (BCWP) 9/20/2014 Ardavan Asef-Vaziri 7-2

  3. Control System Example 1 Week 2: Task expenses = 460 worker-hours Actual Is the task “out of control”? Planned 9/20/2014 Ardavan Asef-Vaziri 7-3

  4. 600 500 400 Worker-hours 300 200 100 0 1 2 3 4 Week Control System Example 1 Week 3: Task expenses = 500 worker-hrs Actual Planned Again, is the task “out of control”? 9/20/2014 Ardavan Asef-Vaziri 7-4

  5. Controlling Projects • Key decisions in controlling performance in project management: • What is the optimal review frequency? • What are appropriate acceptance levels at each review stage? • “Both over-managed and under-managed development processes result in lengthy design lead time and high development costs.” • R.H. Ahmadi, R. Wang. 1999. Managing Development Risk in Product Design Processes. Operations Research 47, 235-246 9/20/2014 Ardavan Asef-Vaziri 7-5

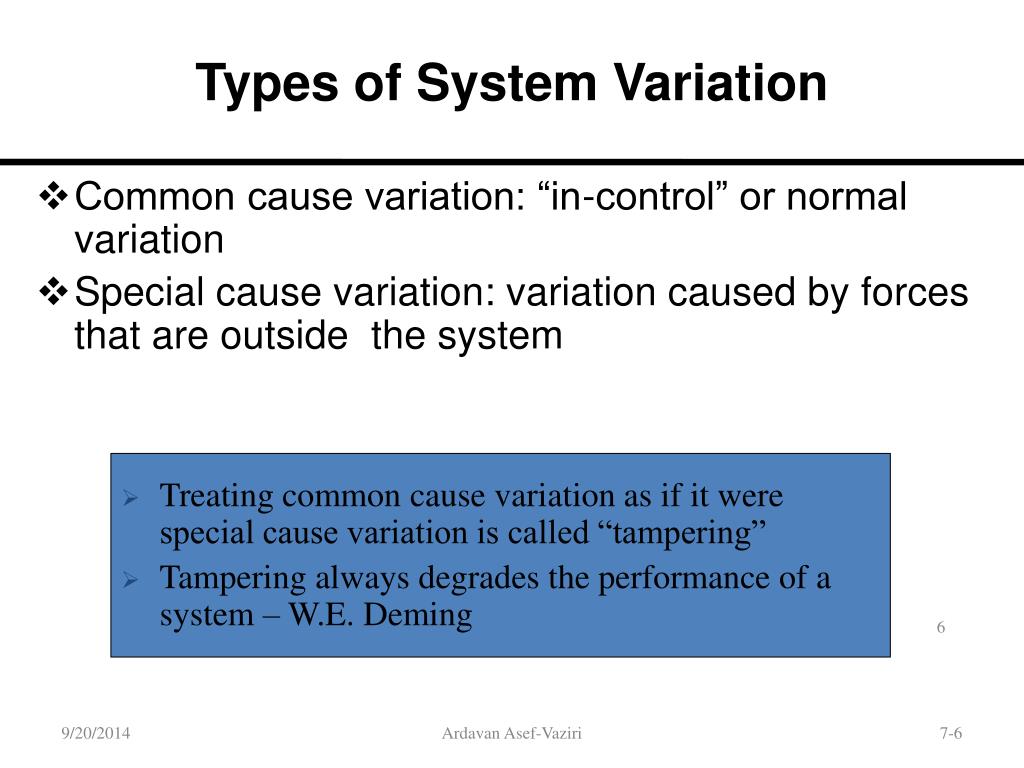

  6. Types of System Variation • Common cause variation: “in-control” or normal variation • Special cause variation: variation caused by forces that are outside the system • Treating common cause variation as if it were special cause variation is called “tampering” • Tampering always degrades the performance of a system – W.E. Deming 9/20/2014 Ardavan Asef-Vaziri 7-6

  7. Performance Metrics for Example 1 PV: Planned Value, baseline cost of scheduled work. AC: Actual cost of work performed. EV: Earned Value, budgeted cost of work performed. PWC: percentage of work completed. 9/20/2014 Ardavan Asef-Vaziri 7-7

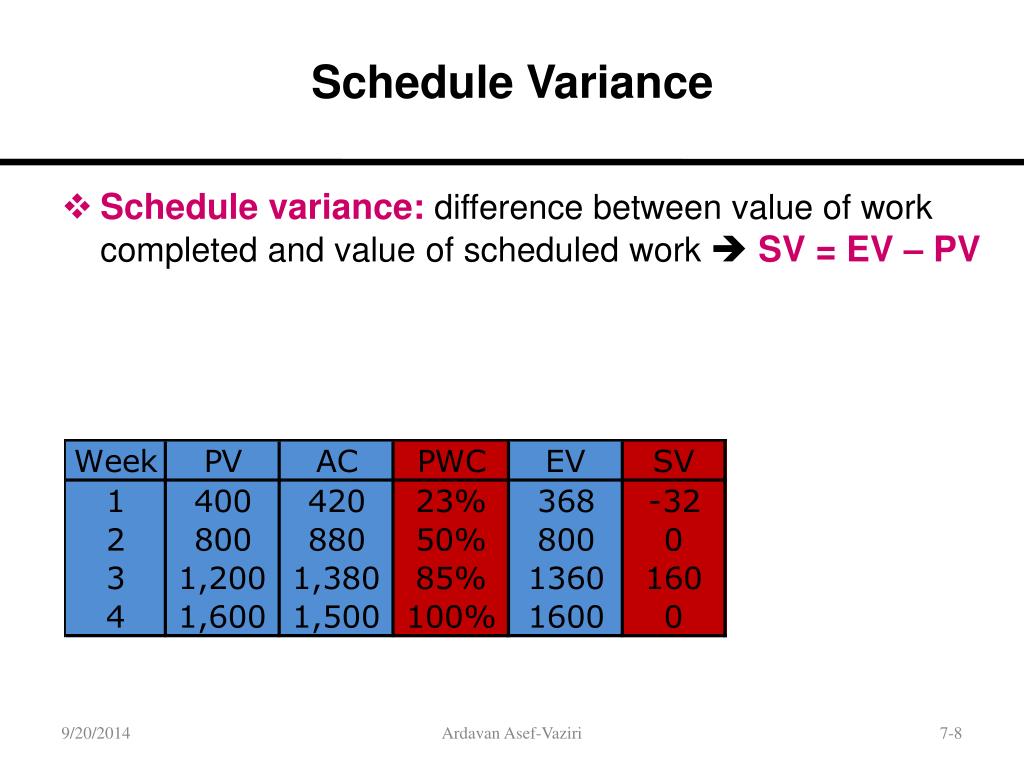

  8. Schedule Variance Schedule variance: difference between value of work completed and value of scheduled work SV = EV – PV 9/20/2014 Ardavan Asef-Vaziri 7-8

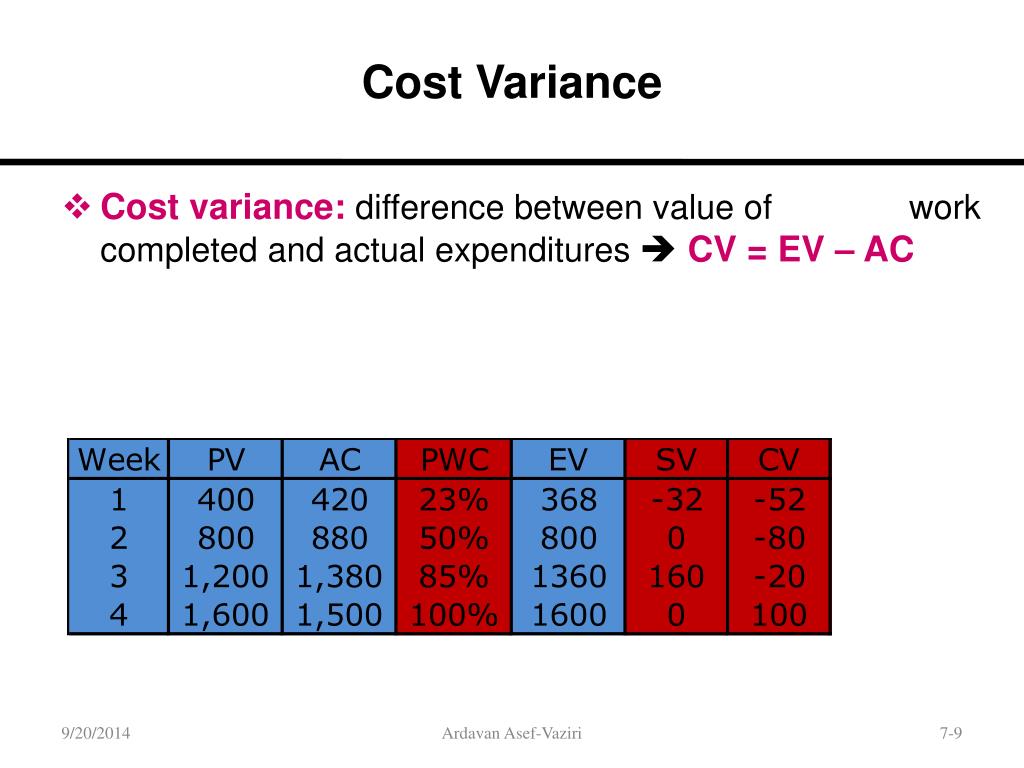

  9. Cost Variance Cost variance: difference between value of work completed and actual expenditures  CV = EV – AC 9/20/2014 Ardavan Asef-Vaziri 7-9

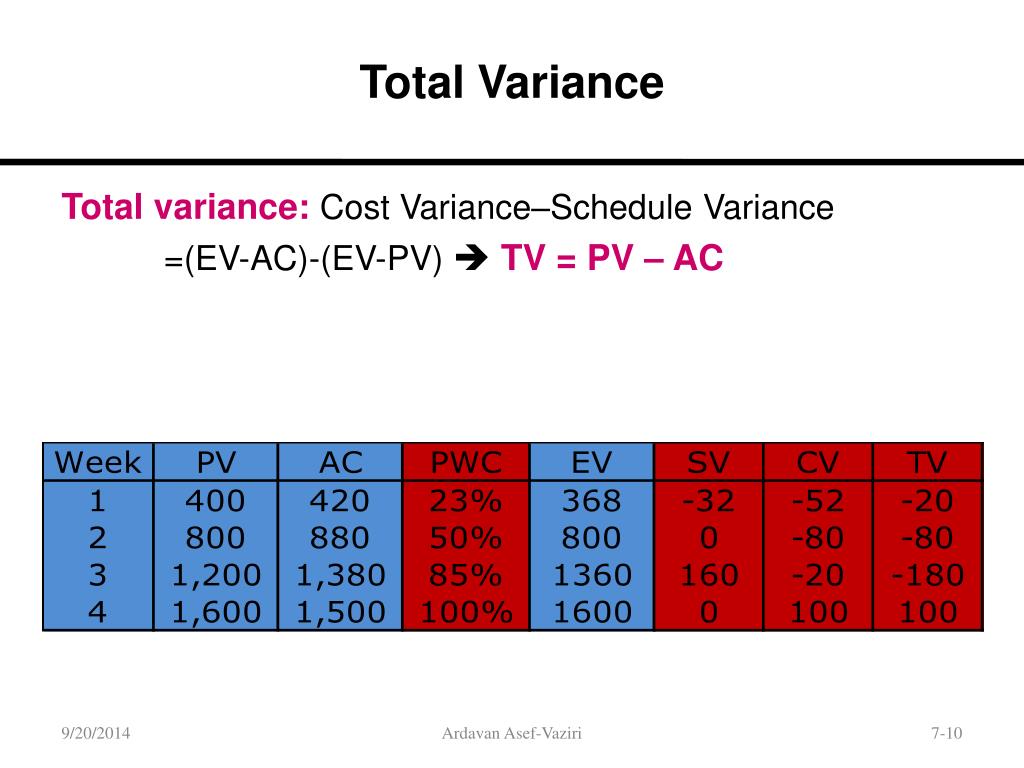

  10. Total Variance Total variance: Cost Variance–Schedule Variance =(EV-AC)-(EV-PV)  TV = PV – AC 9/20/2014 Ardavan Asef-Vaziri 7-10

  11. Earned Value Chart PV (baseline) Dollars AC Cost variance Actual cost Schedule variance EV Value completed (Earned Value) Now Time 9/20/2014 Ardavan Asef-Vaziri 7-11

  12. Earned Value Chart 2 AC Dollars PV EV Time 9/20/2014 Ardavan Asef-Vaziri 7-12

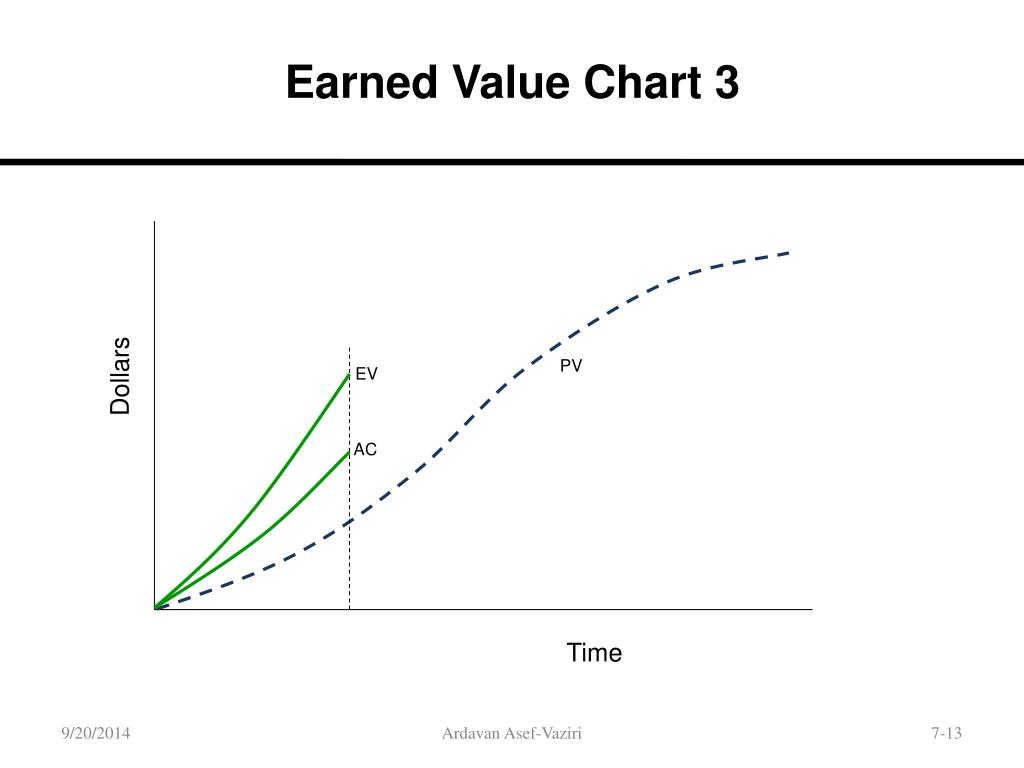

  13. Earned Value Chart 3 PV Dollars EV AC Time 9/20/2014 Ardavan Asef-Vaziri 7-13

  14. Earned Value Chart 4 Dollars PV AC EV Time 9/20/2014 Ardavan Asef-Vaziri 7-14

  15. Earned Value Chart 5 Dollars PV EV AC Time 9/20/2014 Ardavan Asef-Vaziri 7-15

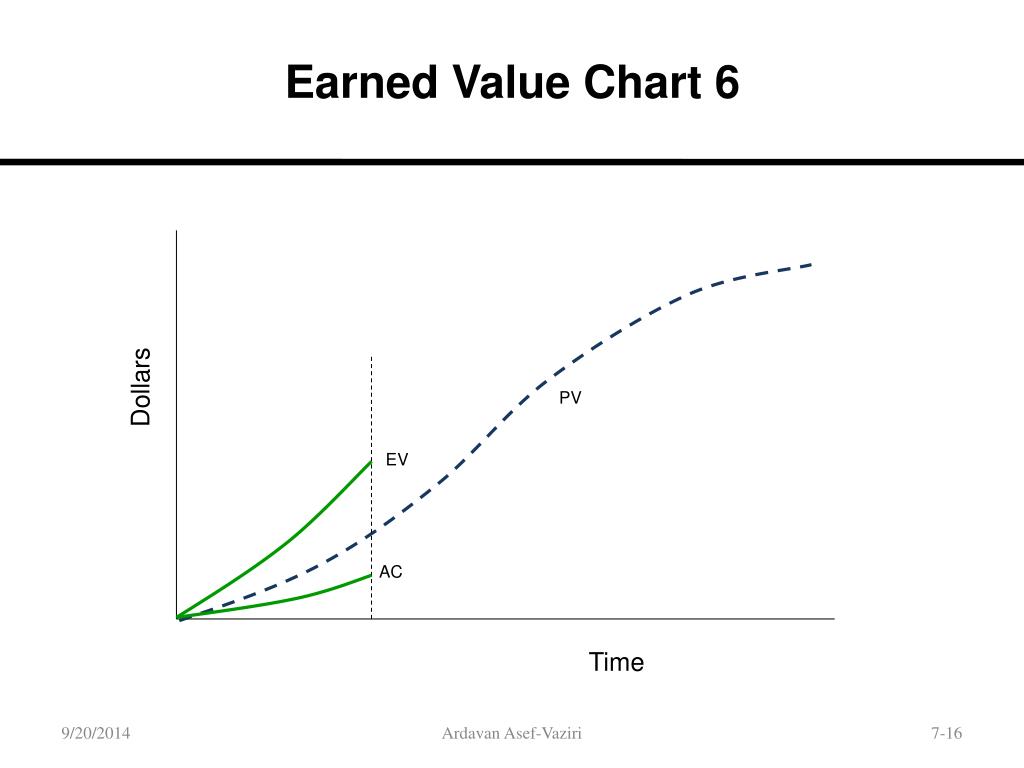

  16. Earned Value Chart 6 Dollars PV EV AC Time 9/20/2014 Ardavan Asef-Vaziri 7-16

  17. Control System Example 2 Progress report at the end of week #5: Cumulative Percent of Work Completed: Worker-Hours Charged to Project: 9/20/2014 Ardavan Asef-Vaziri 7-17

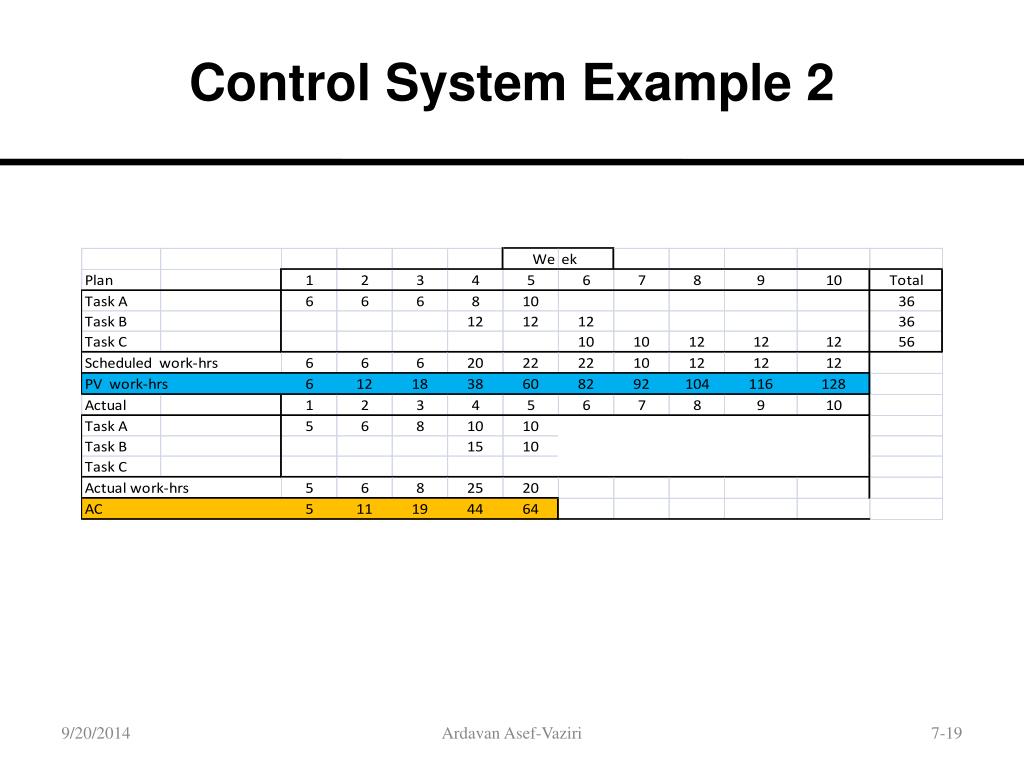

  18. Control System Example 2 9/20/2014 Ardavan Asef-Vaziri 7-18

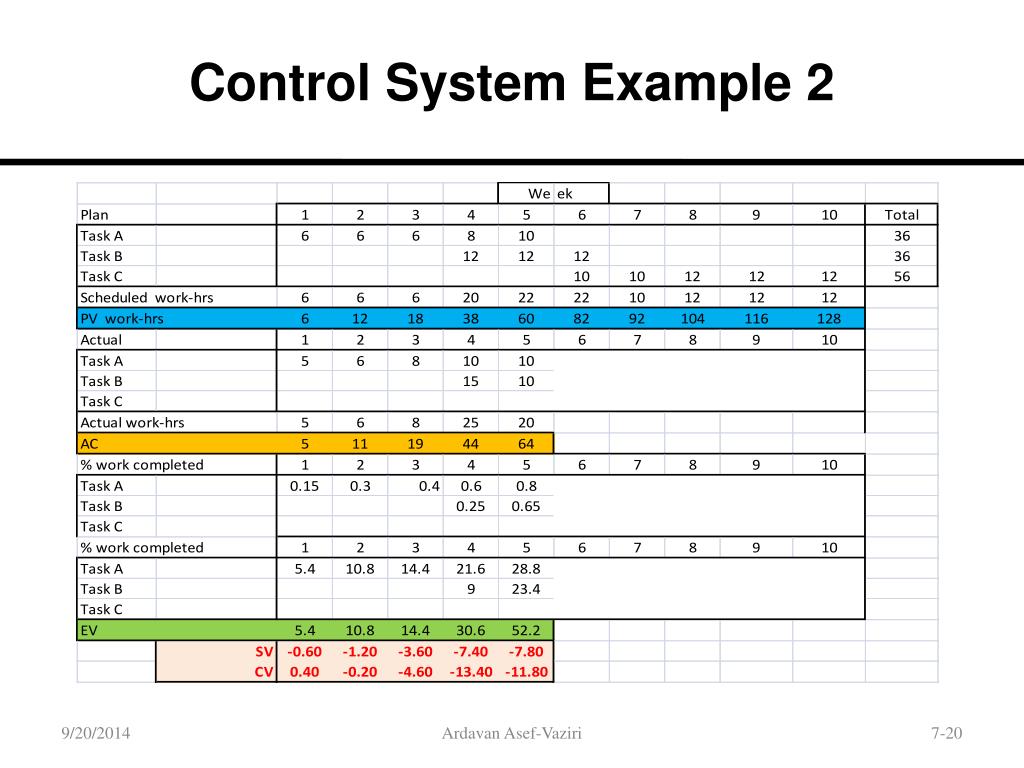

  19. Control System Example 2 9/20/2014 Ardavan Asef-Vaziri 7-19

  20. Control System Example 2 9/20/2014 Ardavan Asef-Vaziri 7-20

  21. Schedule and Cost Indices SPI: Schedule Performance Index  SPI = EV / PV CPI: Cost Performance Index CPI = EV / AC 9/20/2014 Ardavan Asef-Vaziri 7-21

  22. Budget and Estimate at Completion 9/20/2014 BAC: Budget At Completion EAC: Estimate At Completion ETC: Estimated to Completion Ardavan Asef-Vaziri 7-22

  23. Updating Forecasts: Future is the same as actual Assumes that the progress in future is the same as actual 9/20/2014 Ardavan Asef-Vaziri 7-23

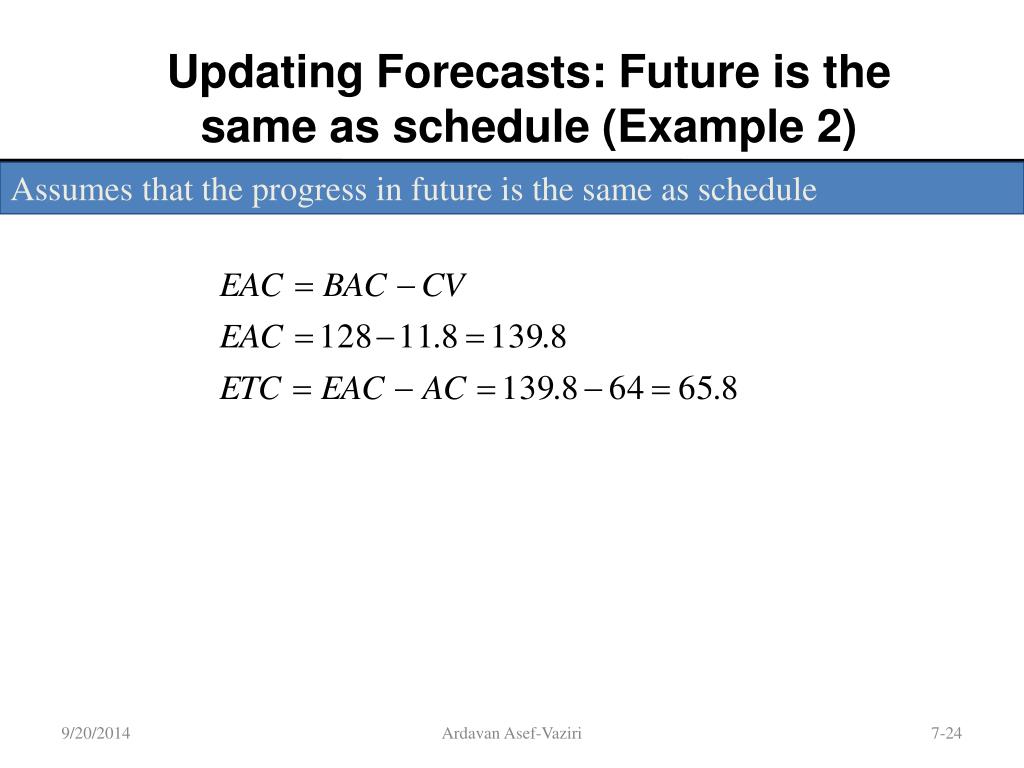

  24. Updating Forecasts: Future is the same as schedule (Example 2) Assumes that the progress in future is the same as schedule 9/20/2014 Ardavan Asef-Vaziri 7-24

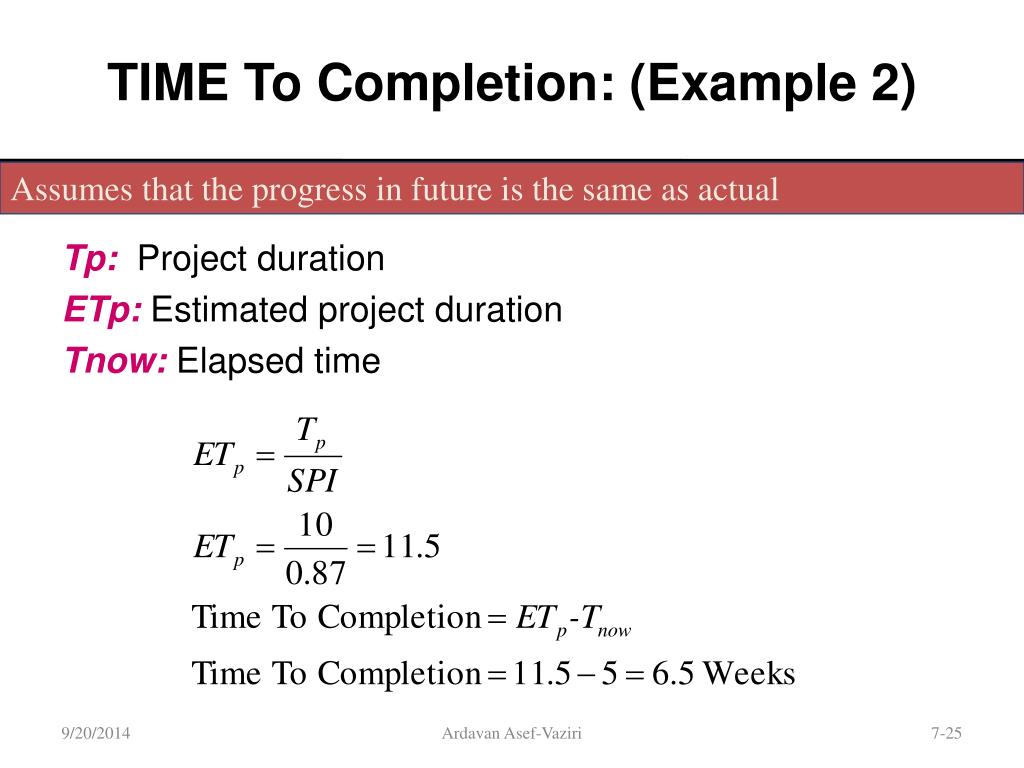

  25. TIME To Completion: (Example 2) Assumes that the progress in future is the same as actual 9/20/2014 Tp: Project duration ETp:Estimated project duration Tnow:Elapsed time Ardavan Asef-Vaziri 7-25

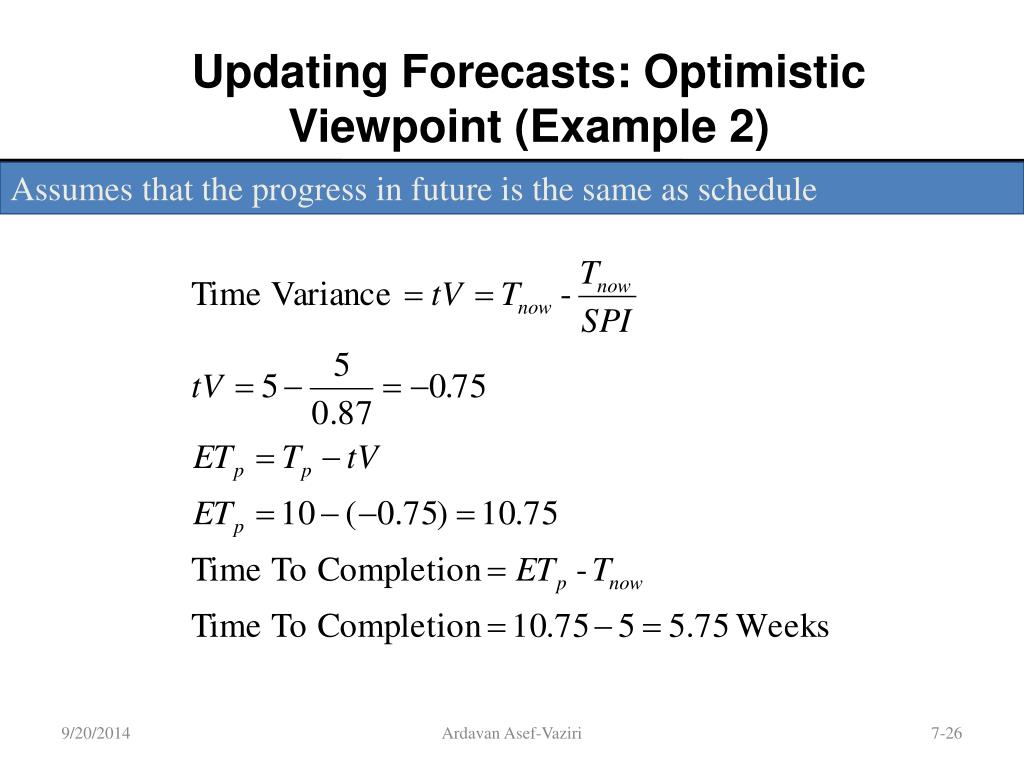

  26. Updating Forecasts: Optimistic Viewpoint (Example 2) Assumes that the progress in future is the same as schedule 9/20/2014 Ardavan Asef-Vaziri 7-26

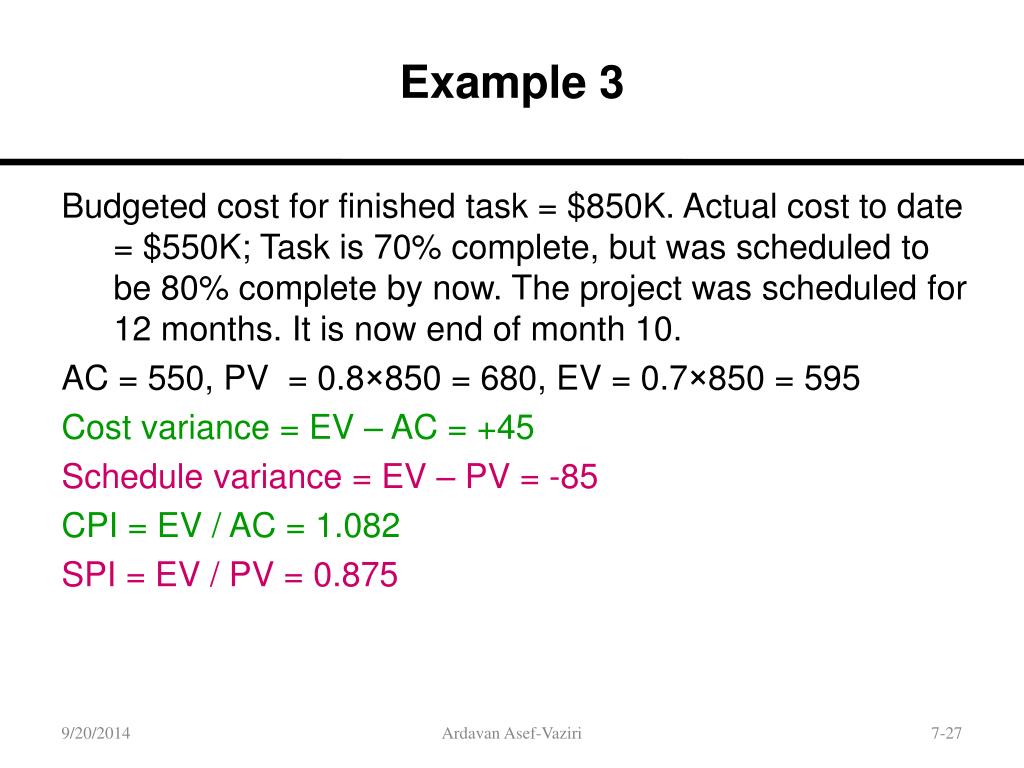

  27. Example 3 Budgeted cost for finished task = $850K. Actual cost to date = $550K; Task is 70% complete, but was scheduled to be 80% complete by now. The project was scheduled for 12 months. It is now end of month 10. AC = 550, PV = 0.8×850 = 680, EV = 0.7×850 = 595 Cost variance = EV – AC = +45 Schedule variance = EV – PV = -85 CPI = EV / AC = 1.082 SPI = EV / PV = 0.875 9/20/2014 Ardavan Asef-Vaziri 7-27

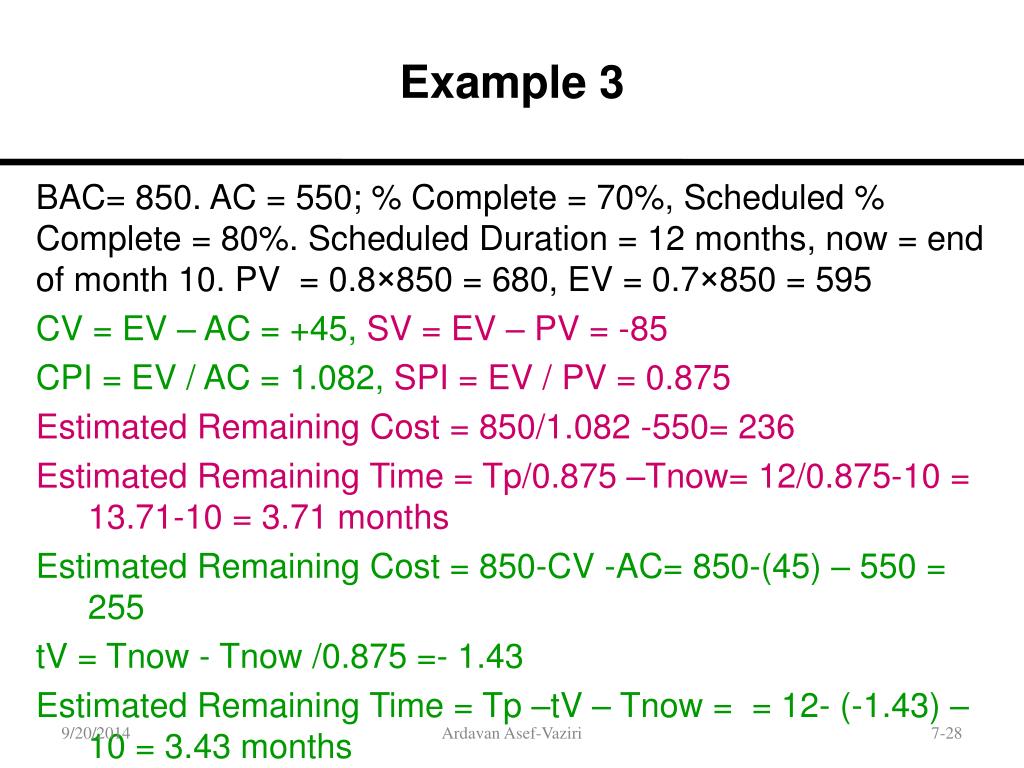

  28. Example 3 BAC= 850. AC = 550; % Complete = 70%, Scheduled % Complete = 80%. Scheduled Duration = 12 months, now = end of month 10. PV = 0.8×850 = 680, EV = 0.7×850 = 595 CV = EV – AC = +45, SV = EV – PV = -85 CPI = EV / AC = 1.082, SPI = EV / PV = 0.875 Estimated Remaining Cost = 850/1.082 -550= 236 Estimated Remaining Time = Tp/0.875 –Tnow= 12/0.875-10 = 13.71-10 = 3.71 months Estimated Remaining Cost = 850-CV -AC= 850-(45) – 550 = 255 tV = Tnow - Tnow /0.875 =- 1.43 Estimated Remaining Time = Tp –tV – Tnow = = 12- (-1.43) – 10 = 3.43 months 9/20/2014 Ardavan Asef-Vaziri 7-28

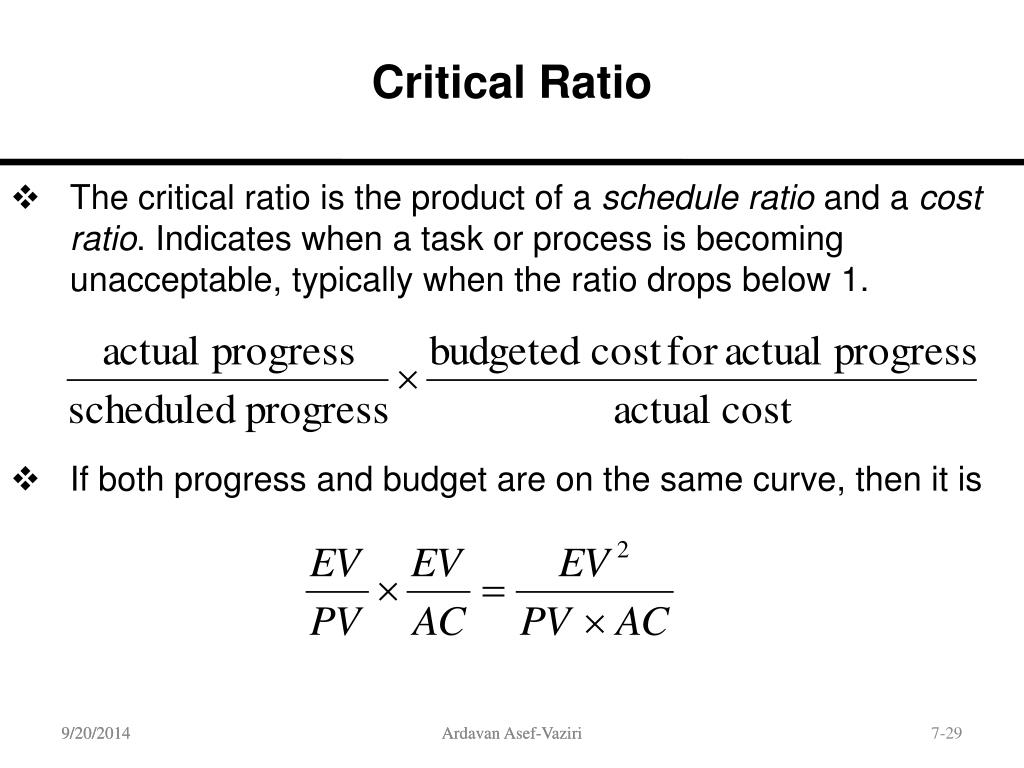

  29. Critical Ratio The critical ratio is the product of a schedule ratio and a cost ratio. Indicates when a task or process is becoming unacceptable, typically when the ratio drops below 1. 9/20/2014 9/20/2014 If both progress and budget are on the same curve, then it is Ardavan Asef-Vaziri Ardavan Asef-Vaziri 7-29

  30. Monitoring the Critical Ratio Although Task 1 is behind schedule, the cost is correspondingly below budget so everything is fine if lateness is no problem for this activity. Task 2 is on budget but progress is lacking so too much money was spent than should have been spent; when the project is completed, it will probably go over budget. 9/20/2014 9/20/2014 Ardavan Asef-Vaziri Ardavan Asef-Vaziri 7-30

  31. Critical Ratios With Control Limits 9/20/2014 Ardavan Asef-Vaziri 7-31

  32. Cost Control Chart 9/20/2014 Ardavan Asef-Vaziri 7-32
