Introduction to Earned Value Analysis

Introduction to Earned Value Analysis. What is Earned Value Concept. It is a technique for monitoring and tracking project progress. C/SCSC = Cost and Schedule Control System Criteria. It provides Cost and Schedule Integration. It was developed by Department of Defense. (DOD). B.

tannar
Télécharger la présentation

Introduction to Earned Value Analysis

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Introduction to Earned Value Analysis

  2. What is Earned Value Concept • It is a technique for monitoring and tracking project progress. • C/SCSC = Cost and Schedule Control System Criteria. • It provides Cost and Schedule Integration. • It was developed by Department of Defense. (DOD)

  3. B actual budget time Traditional Barchart • Traditional Barchart and S-Curve provides comparison between actual progress and budget progress. • It does not provide accuracy comparison in term of time, cost separately. • It does not show reasons of project problems.

  4. What is Earned Value Concept • Total project Budget is 1,000,000 Baht. • Total Project Duration is 10 Month. • We have passed 6 Months. • We have already spent 500,000 Baht, • What is our time status ? • What is our cost status ? • What should we do ? • If we got 55% work done.

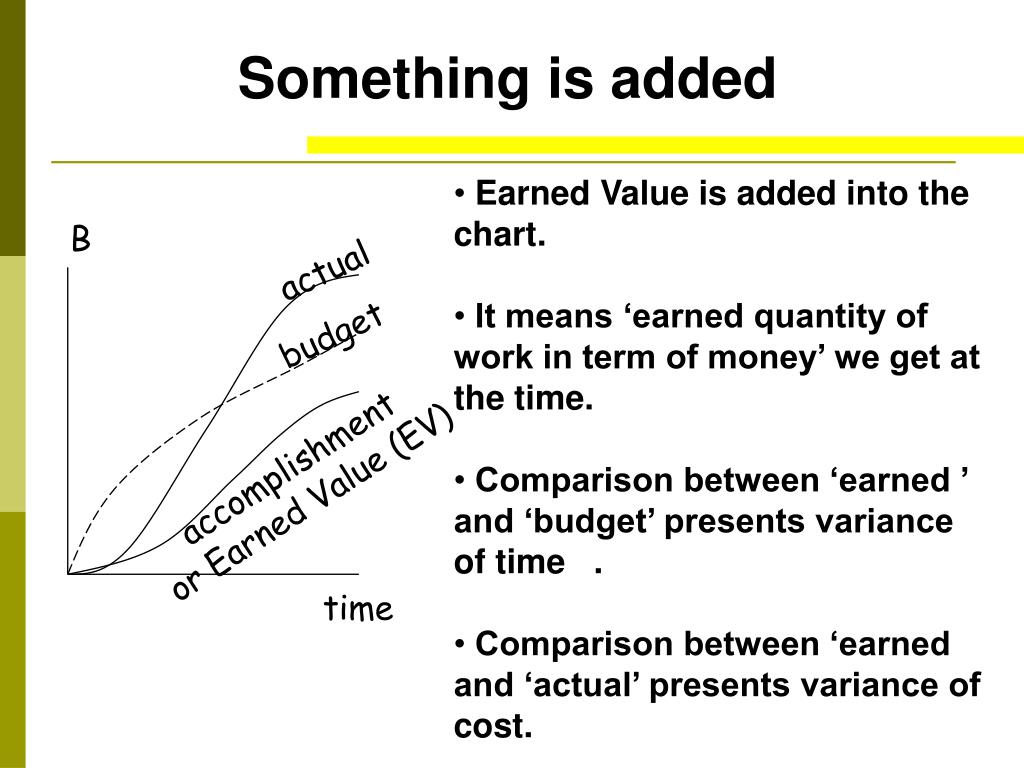

  5. B actual budget accomplishment or Earned Value (EV) time Something is added • Earned Value is added into the chart. • It means ‘earned quantity of work in term of money’ we get at the time. • Comparison between ‘earned ’ and ‘budget’ presents variance of time . • Comparison between ‘earned and ‘actual’ presents variance of cost.

  6. Earned Value Concept • Main Variables • BCWS - Budget Cost of Work Schedule =งานตามเป้าหมาย เราควรจะทำงานได้เท่าไรแล้ว ? มาจากการวางแผน • ACWP - Actual Cost of Work Performed =เงินที่จ่ายไปจริงคือเท่าไร ? มาจากการบันทึกทรัพยากรที่ใช้ไปจริง และเงินที่จ่ายสำหรับงาน • BCWP - Budget Cost of Work Performed =งานที่ทำได้จริง เราได้งานเท่าไร ? มาจากการวัดปริมาณงานที่ทำได้จริง

  7. BCWP Measurement • Two types of Calculation • BCWP = % of Work CompletedxPlanned Cost per Percentage • BCWP = Quantity of Work done x Unit Cost of Work Planned. • งานที่ทำได้ = ร้อยละของงานที่เกิดขึ้น x ราคาต่อร้อยละของงาน • งานที่ทำได้ = หน่วยของงานที่ทำได้ x ราคาต่อหน่วยตามแผน

  8. Schedule Variance (SV) • SV = BCWP - BCWS • SPI (Schedule performance index) = BCWP/BCWS • SVP (SV Percent) = SV x 100 / BCWS • You planned to finish task A in 10 days which total quantity is 10 unit. Schedule cost of the task is 1,000. After 10 days, you have got only 90% complete (9 units completed) • BCWS = 1000 • BCWP = 90 (%) x 10 (Baht/%) or = 9 (Units) x 100 (Baht per unit) = 900 • SV = BCWP - BCWS = 900-1000 = -100 • SPI = 900/100 = 0.9 • SVP = -100/1000 = -10%  Behind Schedule.

  9. schedule (BCWS) SV earned (BCWP) months behind Schedule Variance (SV) • SV = -100 • SPI = 0.9 • SVP = -10%  Behind Schedule. • How much? • = 10% of the Period

  10. Cost Variance (CV) • CV = BCWP - ACWP • CPI (Cost Performance Index) = BCWP/ACWP • CVP (CV Percent) = CV x 100 / BCWP • You planned to finish task A in 10 days which total quantity is 10 unit. Schedule cost of the task is 1,000. After 10 days, you have got only 90% complete (9 units completed). You have already spent 950. • BCWS = 1000 BCWP = 900 • ACWP = 950 • CV = BCWP – ACWP = 900-950 = -50 • CPI = 900/950 = 0.947 • CVP = -50/900 = -5.56%  Cost Overrun

  11. (CV and SV) CV, SV > 0 Good (Ahead or under run) = 0 OK - On Schedule., on budget < 0 Bad - Behind, overrun CVP, SVP > 0 Good (Ahead or under run) = 0 OK - On Schedule., on budget < 0 Bad - Behind, overrun CPI, SPI > 1 Good (Ahead or under run) = 1 OK - On Schedule., on budget < 1 Bad - Behind, overrun

  12. B schedule actual CV SV earned time CV and SV

  13. Example • Total budget (BAC) = 5000 • part way through project • Work scheduled (BCWS) = 2000 • Work accomplished (BCWP) = 1800 • Actual cost (ACWP) = 2400 • SV, SVP, SPI = ? • CV, CVP, CPI = ? • Report status of this project. • Recommend some actions.

  14. positive variance zero schedule variance negative variance cost variance Trend Analysis

  15. +10% 1.1 +0% 1.0 -10% 0.9 -20% 0.8 CPI CV% +10% 1.1 +0% 1.0 -10% 0.9 -20% 0.8 SV% SPI Trend Analysis

  16. Cost Prediction • BAC = Budget at Completion งบประมาณทั้งหมดของโครงการที่วางแผนไว้ • ETC = Estimate to Complete ประมาณงบประมาณที่ต้องใช้ • ETC = ประมาณงบประมาณที่ต้องการต่อจากนี้ / CPI = (BAC - BCWP)/CPI • Previous example • ETC = (5000-1800)/CPI = 3200/CPI = ??

  17. Cost Prediction • EAC = Estimate at Completion งบประมาณที่คาดว่าจะต้องใช้ทั้งหมดเมื่อจบโครงการ • EAC = ACWP + ETC = งบประมาณที่ใช้ไปแล้ว + ที่คาดว่าจะใช้ต่อไป • Previous example • EAC = ??

  18. Time Prediction • ETTC = Estimate Time to Complete = ประมาณว่าจะใช้เวลาอีกประมาณเท่าไร= ปริมาณงานที่เหลืออยู่ / ((อัตราการทำงานตามแผน)* SPI) = (BAC- BCWP)/ ((Planned Working Rate)x SPI) • Previous Example, if planned time = 5 months • Working rate = 5000/5 = 1000 / Month • Then, estimated working rate = 1000*SPI • ETTC = (5000-1800)/(1000x SPI) = 3200/SPI = ?? • ETU (Estimate Time Use) = Time Use + ETTC • Do some exercises.
